CallStart Project
photo_library14-Step Visual Guide

Exterior Waterproofing
Step by Step

Follow a real exterior waterproofing project through every phase — inspection, excavation, membrane application, drainage, and backfill. 8 days, 14 steps, 18 photos, zero mystery.

Before: water seeping through basement wall crack
Before

Water seeping through foundation crack

After: completed exterior waterproofing with dry basement
After

Fully waterproofed, dry, and protected

search

Phase 1 of 5

Inspection & Assessment

calendar_monthDay 1
1Interior CheckDay 1

Visual Inspection — Water Seeping Through Crack

The project begins inside the basement. Water seepage through a visible wall crack confirms the problem — moisture is actively penetrating the foundation. This tells us exactly where the exterior waterproofing needs to focus.

Water seeping through basement wall crack during visual inspection
2Exterior CheckDay 1

Outside Inspection — Identifying Crack Causes

Moving outside, the crew inspects the exterior to identify the root cause. Soil settlement, tree roots, poor grading, or hydrostatic pressure — understanding the cause determines the waterproofing approach.

Exterior inspection identifying foundation crack causes
landscape

Phase 2 of 5

Excavation

calendar_monthDays 2–4
schedule

Excavation depth depends on wall height and footing depth. Typical residential walls require digging 6–8 feet down to expose the full foundation. Soil is stockpiled nearby for backfill.

3DigDays 2–3

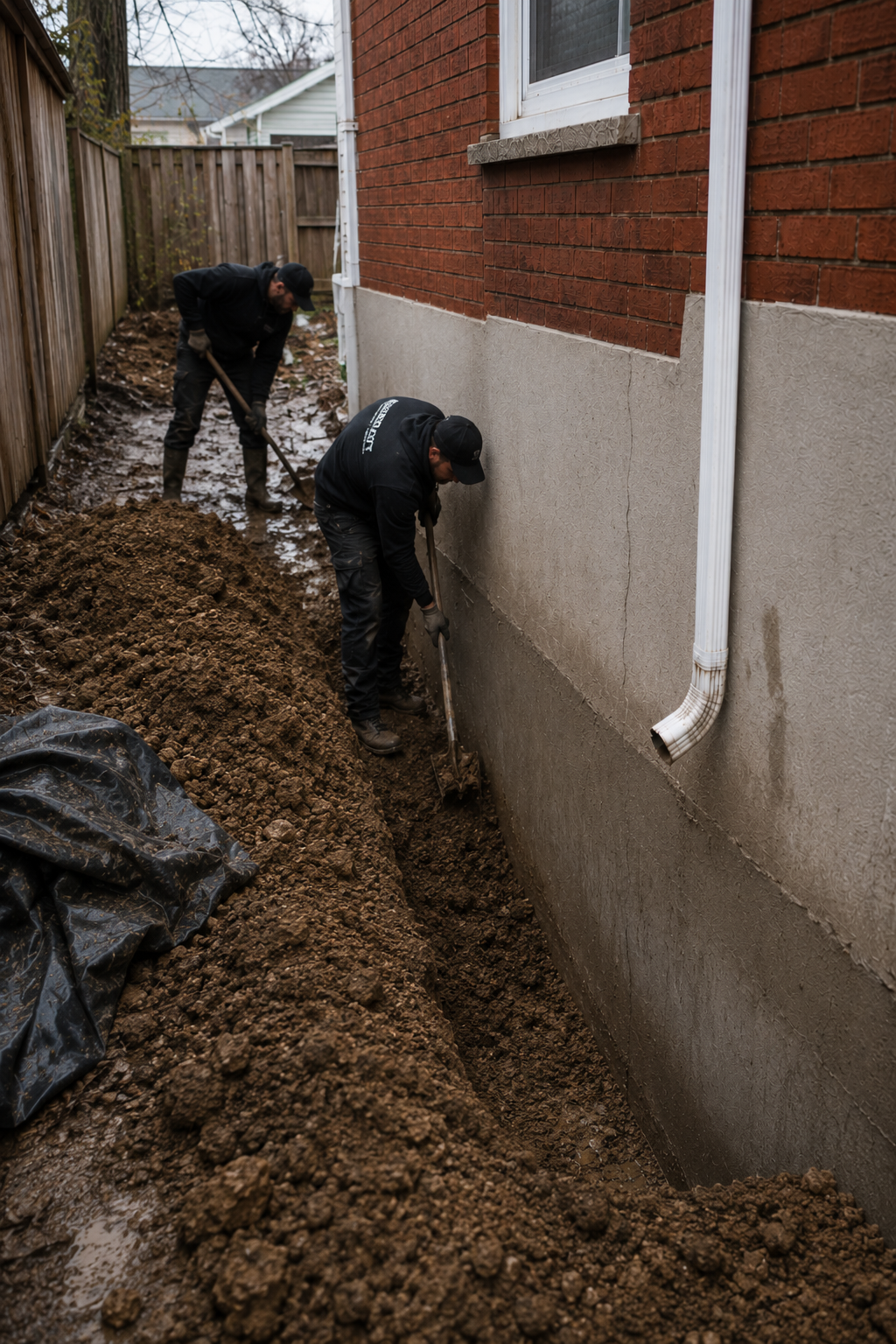

Excavation to Expose Foundation Wall

A trench is excavated along the exterior foundation wall, exposing the full height of the wall down to the footing. This gives access to apply waterproofing materials directly to the concrete surface.

info

The trench is typically 3–4 feet wide to give workers safe access. Shoring may be required for deep excavations per OHSA regulations.

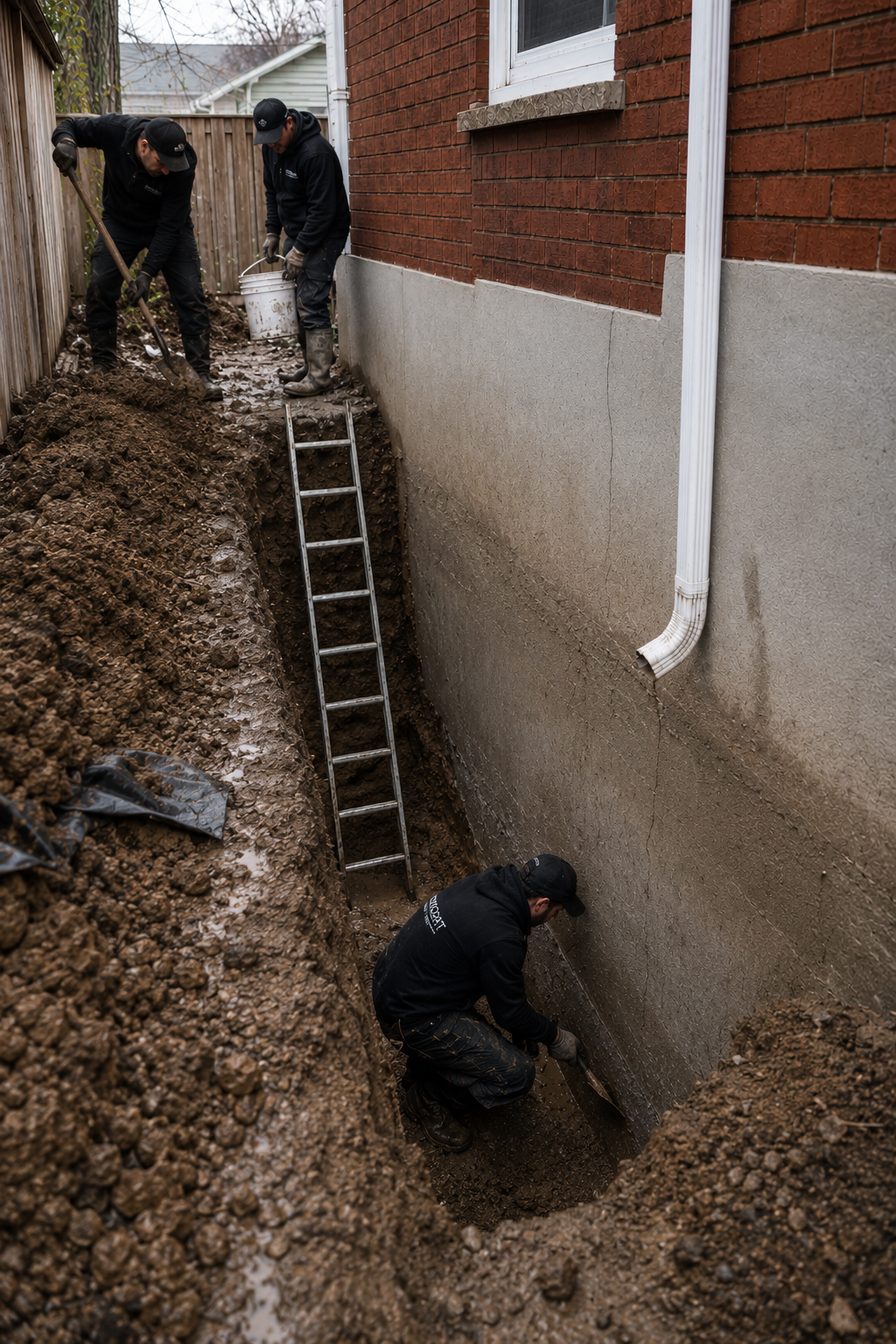

Excavation trench exposing full foundation wall
Excavation progress showing exposed foundation
4CleanDay 4

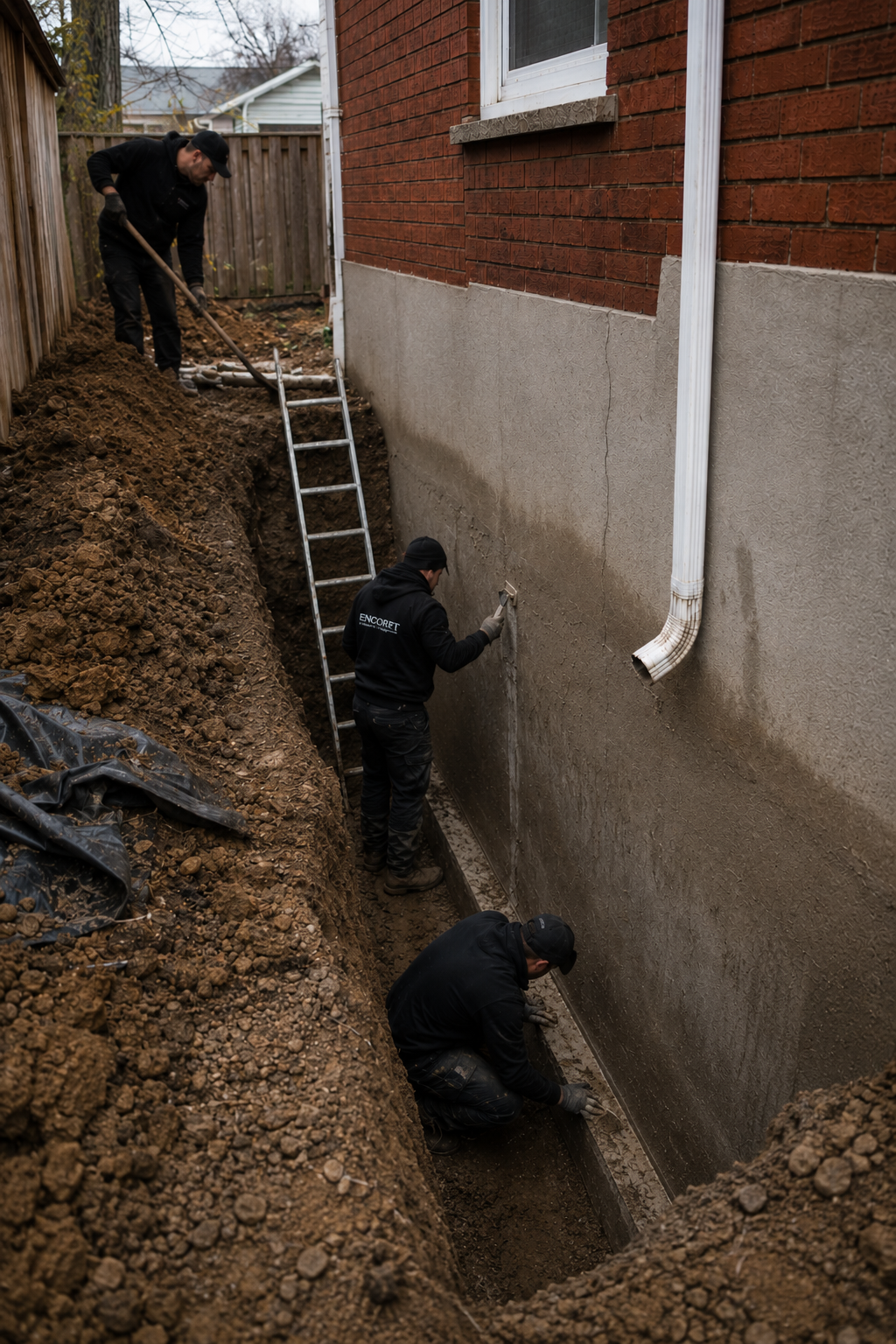

Cleaning Wall from Dirt & Debris

The exposed foundation wall is thoroughly cleaned — all dirt, clay, roots, and loose material are removed. A clean surface is critical for the waterproofing membrane to bond properly.

Foundation wall being cleaned of dirt and debris
format_paint

Phase 3 of 5

Waterproofing Application

calendar_monthDays 4–5
schedule

The liquid membrane needs to cure before the poly layer is applied. In warm weather this can be same-day; in cooler conditions, allow 12–24 hours between coats.

5MembraneDay 4

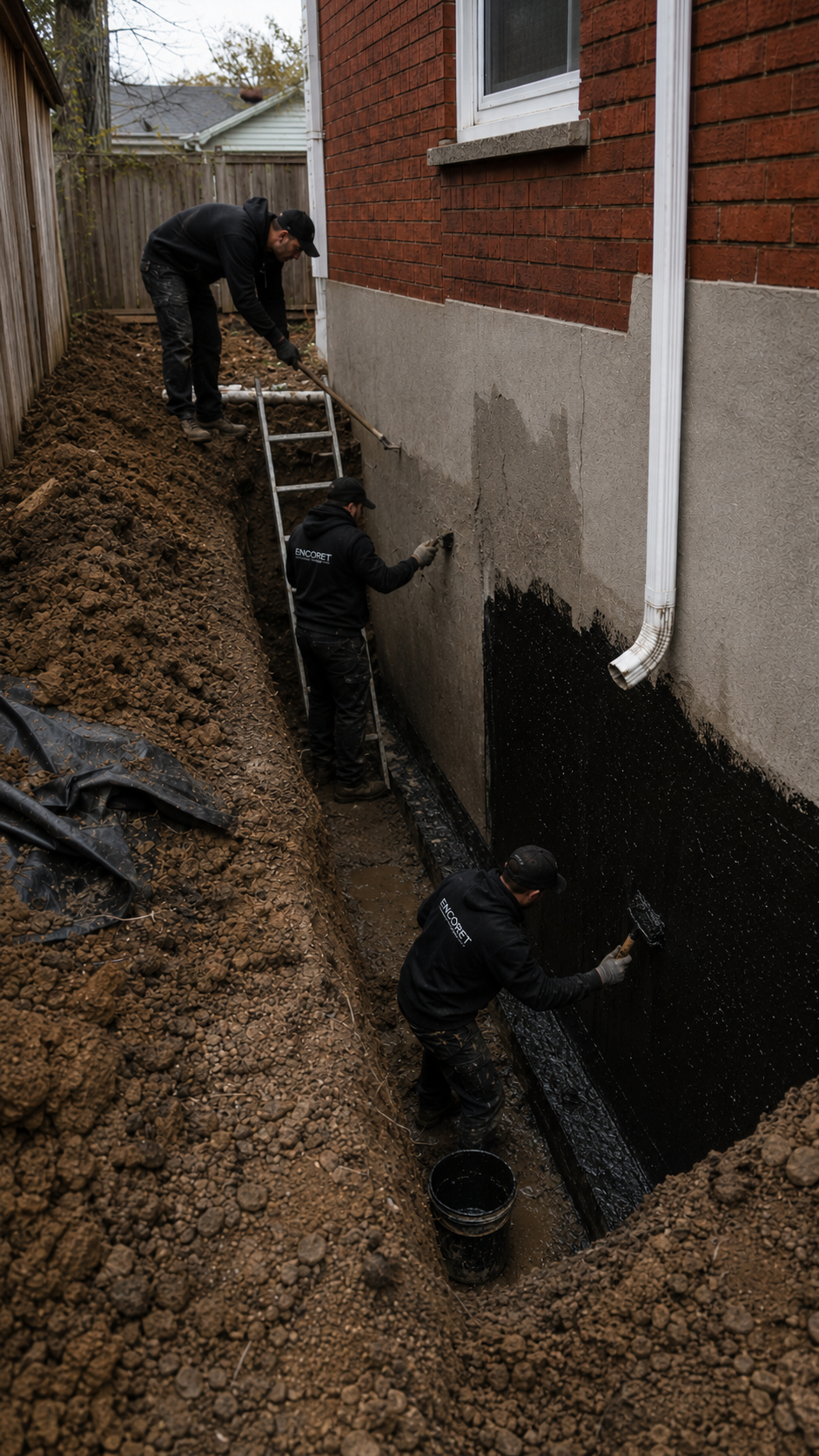

Applying Liquid Waterproofing Membrane

A rubberized liquid waterproofing membrane is applied directly to the clean concrete wall. This creates a seamless, flexible barrier that bridges hairline cracks and prevents water penetration.

info

The membrane is typically applied in two coats for full coverage. It remains flexible after curing, so it won’t crack with normal foundation movement.

Liquid waterproofing membrane being applied to foundation wall
6Poly BarrierDay 5

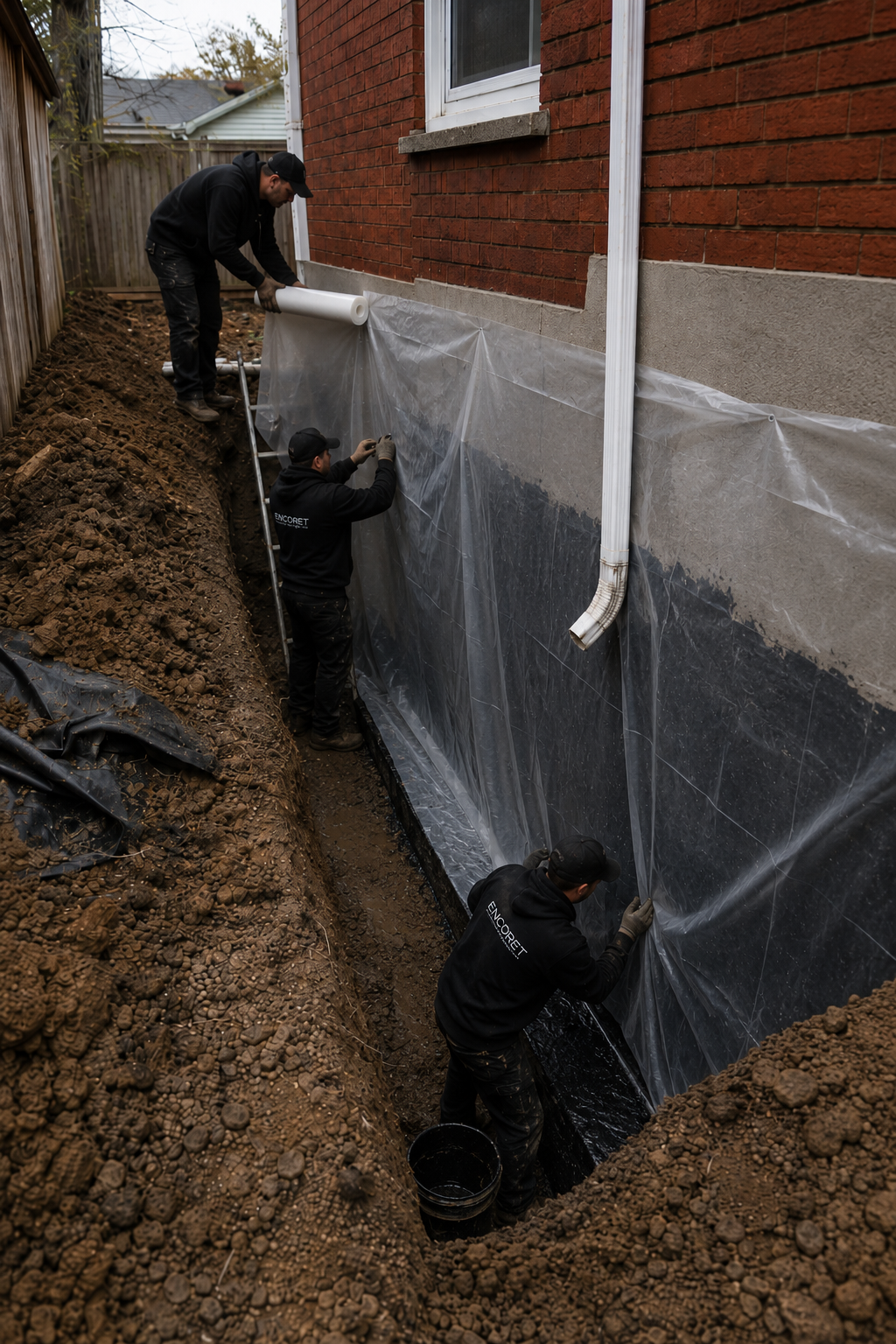

Covering with 6 Mil Poly Vapor Barrier

A 6 mil polyethylene sheet is applied over the cured membrane as an additional vapor barrier. This double-layer system ensures no moisture reaches the foundation wall from the surrounding soil.

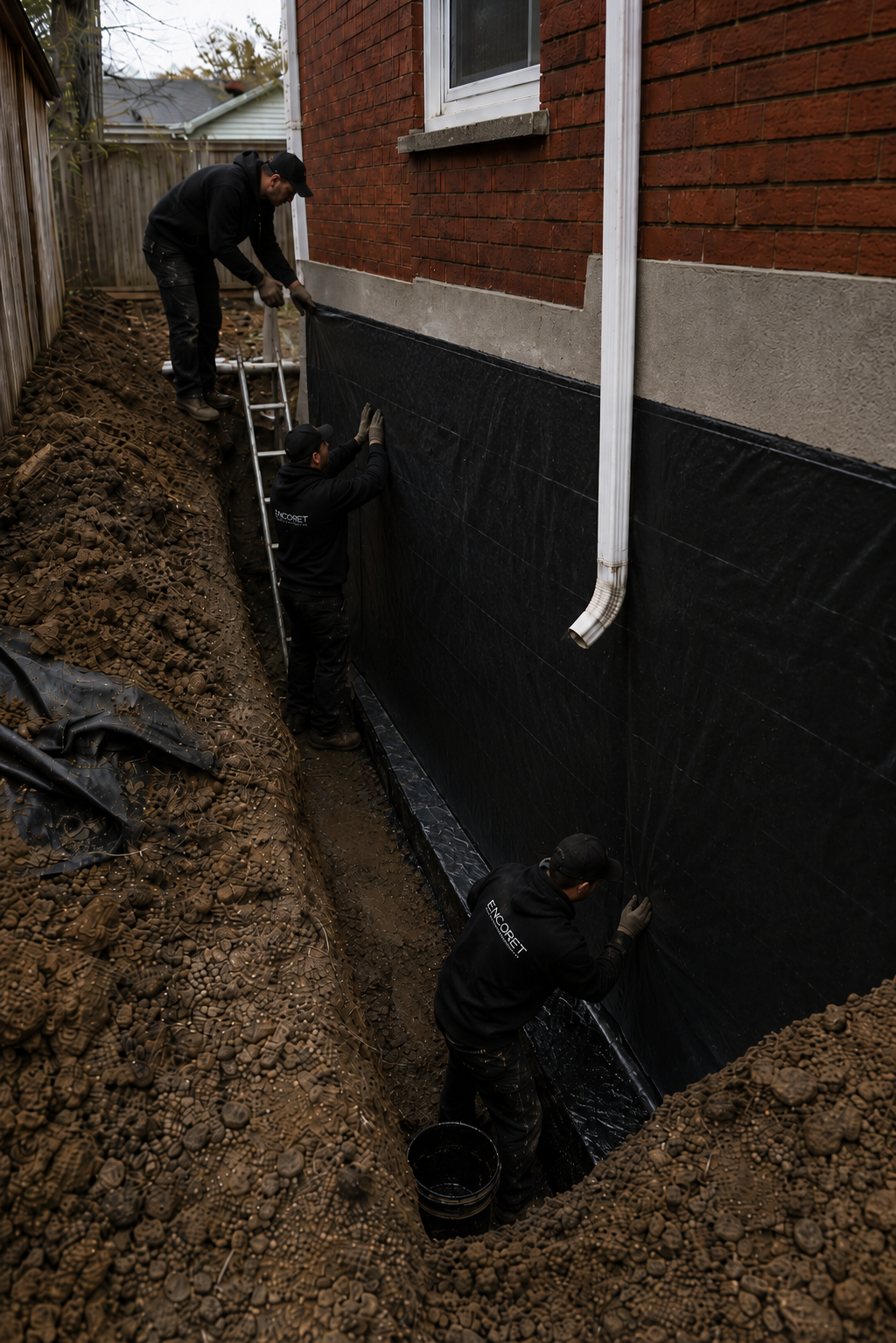

6 mil poly vapor barrier being applied over waterproofing membrane
Poly vapor barrier installation continues along foundation
water_drop

Phase 4 of 5

Drainage System

calendar_monthDays 5–6
schedule

The drainage system works together with the waterproofing membrane — the membrane stops water at the wall, while the weeping tile and gravel redirect groundwater away from the foundation.

7Weeping TileDay 5

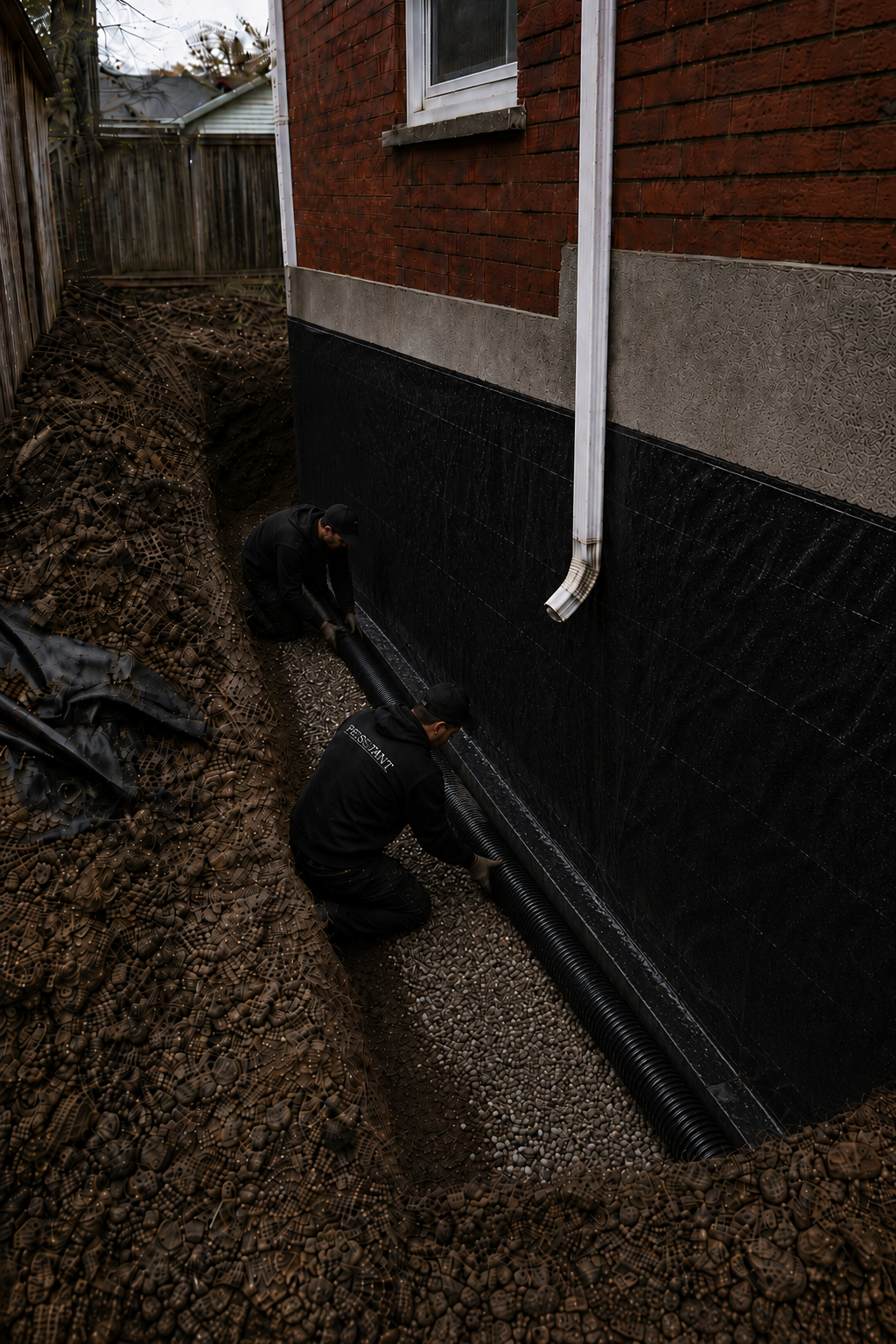

Installing Perforated Drainage Weeping Tile

A perforated 4-inch weeping tile (drain pipe) is laid at the base of the footing, wrapped in filter fabric to prevent clogging. This pipe collects groundwater and directs it away from the foundation to a sump or storm drain.

info

The weeping tile is sloped at a minimum 1% grade to ensure proper drainage. It connects to either a sump pump inside or daylight at the property line.

Perforated weeping tile being installed at foundation footing
8GravelDay 6

Placing Gravel Drainage Layer

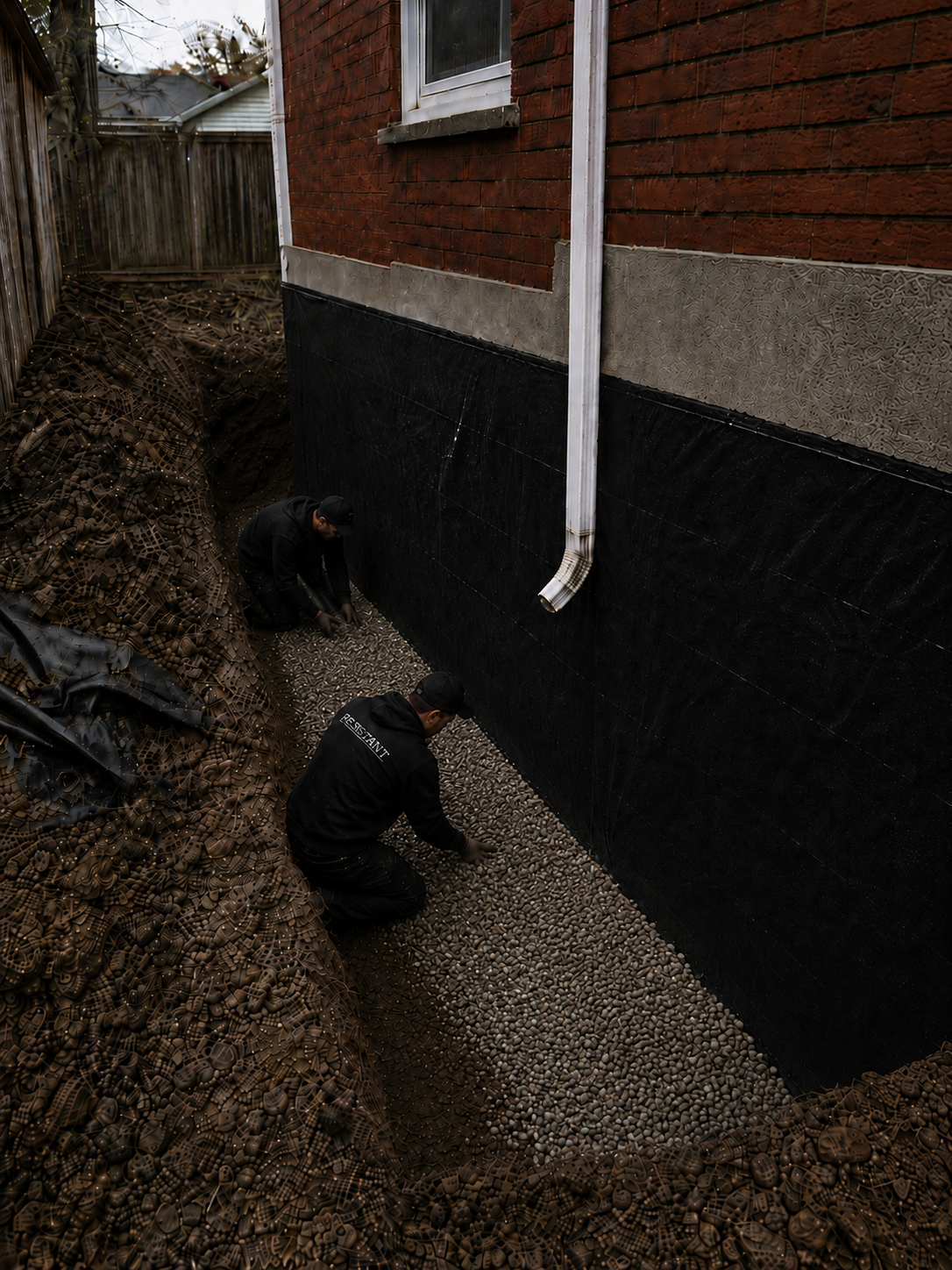

Clean 3/4-inch crushed gravel is placed over and around the weeping tile, creating a free-draining layer. This gravel envelope allows water to flow easily to the drain pipe instead of building up against the wall.

Gravel drainage layer placed over weeping tile
9Dimpled MembraneDay 6

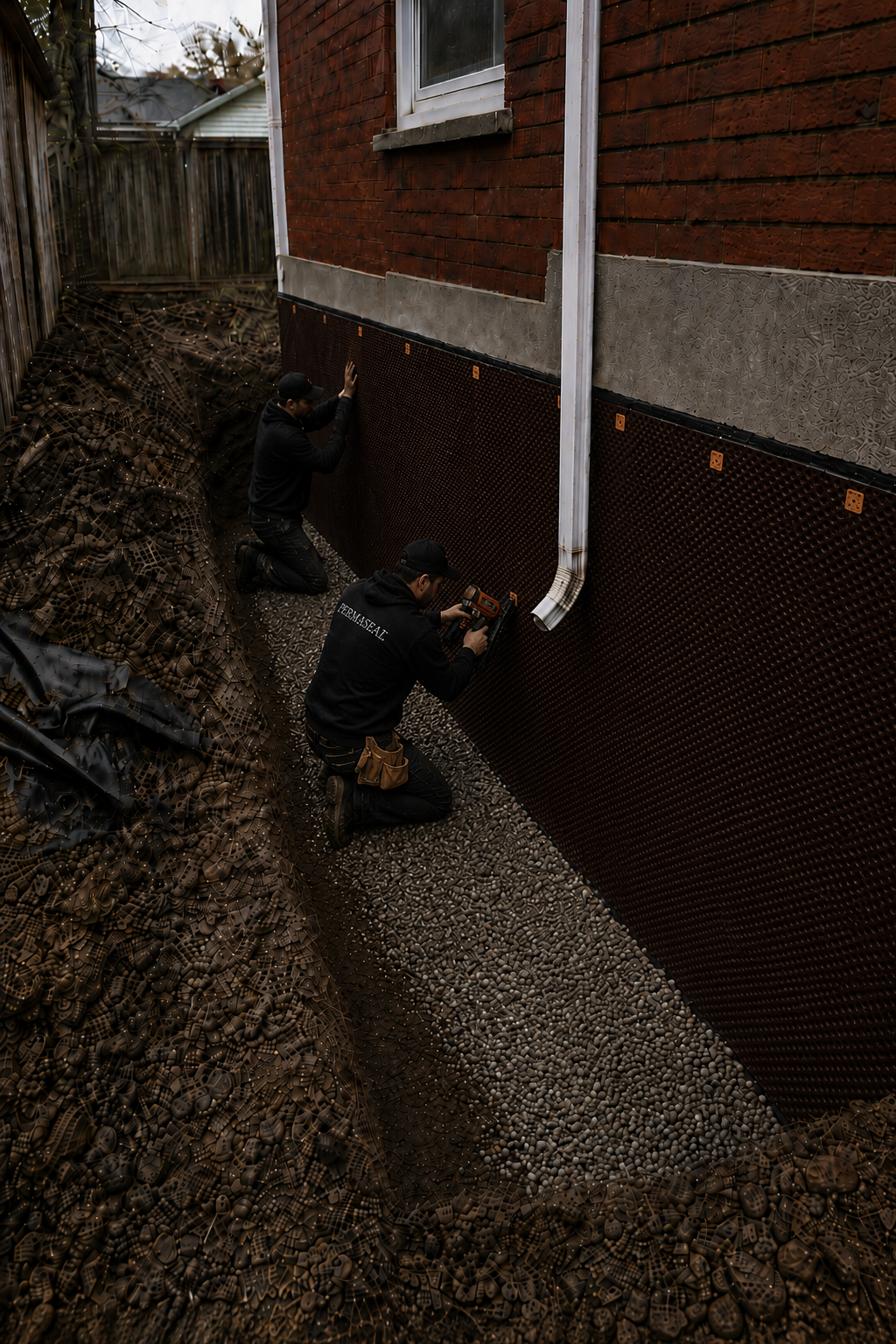

Installing Dimpled Waterproofing Membrane

A high-density polyethylene (HDPE) dimpled membrane is installed over the waterproofed wall. The dimples face outward, creating an air gap that channels water down to the weeping tile while protecting the liquid membrane from backfill damage.

info

The dimpled membrane also provides a thermal break and protects the primary waterproofing layer from root penetration and soil pressure.

Dimpled HDPE waterproofing membrane installed on foundation wall
check_circle

Phase 5 of 5

Backfill & Finishing

calendar_monthDays 6–8
schedule

Backfill is done in 2-foot lifts with compaction between each lift. This prevents settlement that could create negative grading toward the foundation.

10BackfillDay 6

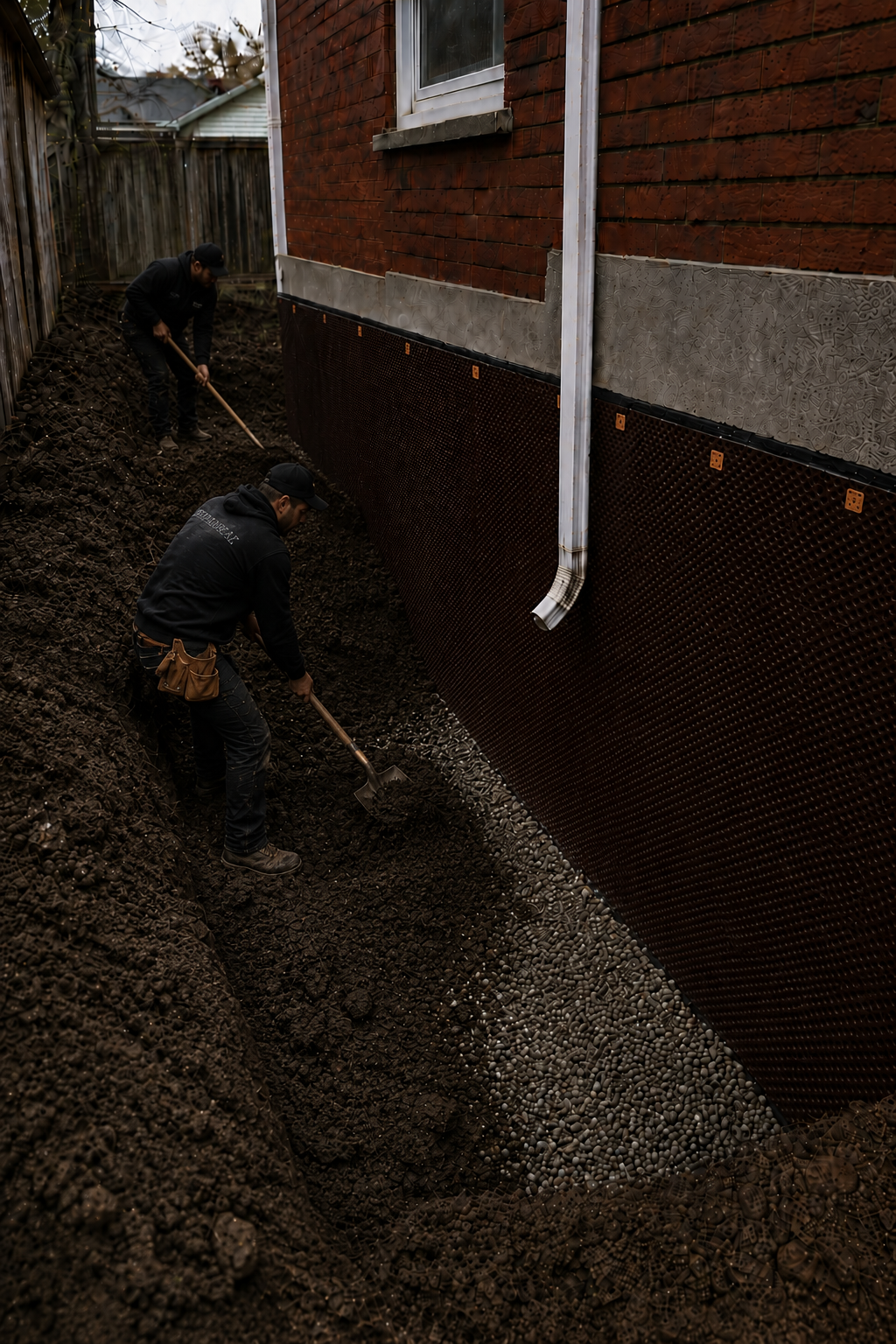

Backfilling the Trench

The excavated soil is returned to the trench in controlled lifts. Each lift is roughly 2 feet deep, allowing proper compaction between layers to prevent future settlement.

Backfilling trench against waterproofed foundation wall
11CompactDays 7–8

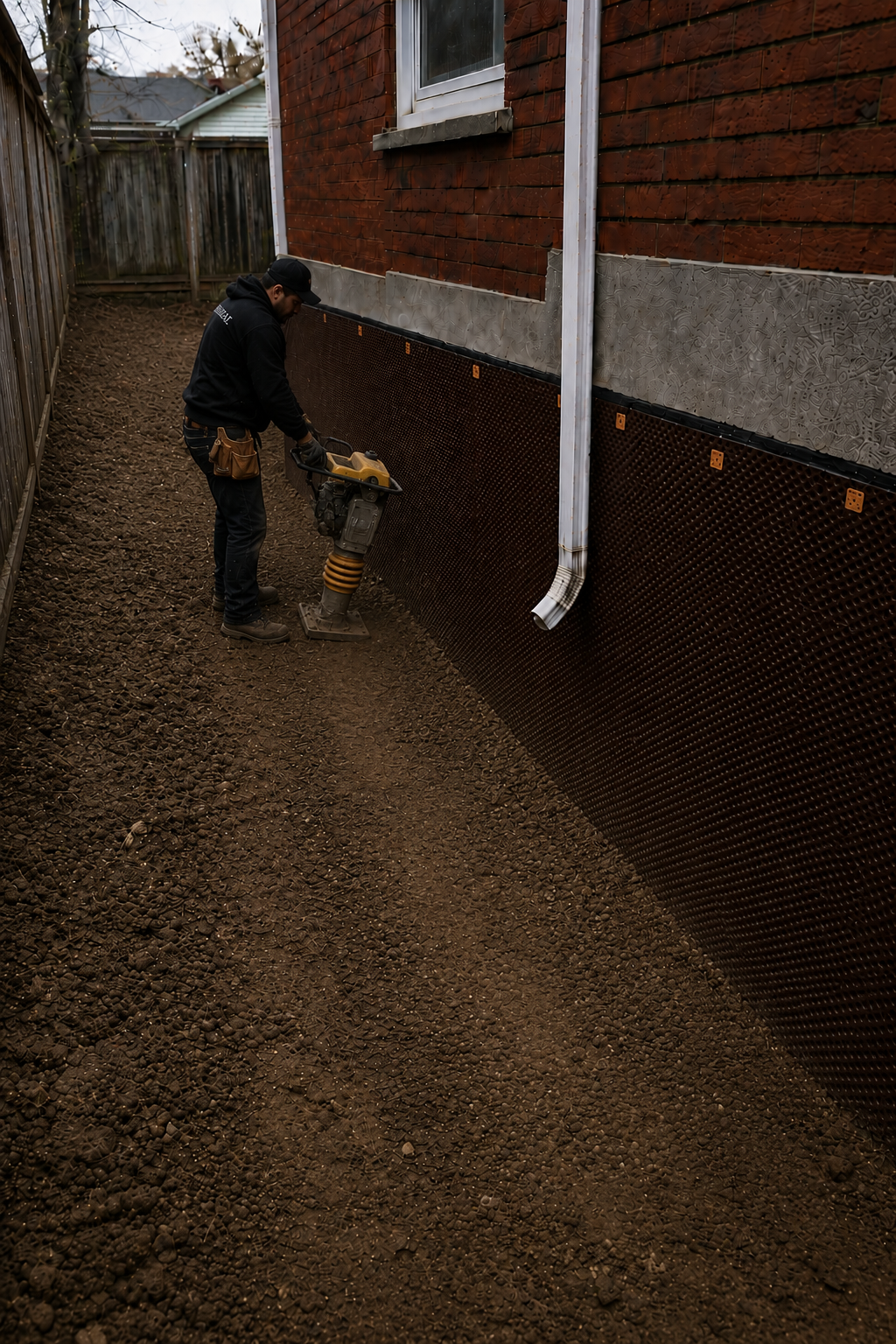

Tamping Soil Every 2 Feet

A plate compactor or hand tamper is used to compact each 2-foot lift of backfill. Proper compaction is critical — without it, the soil settles over time and creates low spots that direct water back toward the foundation.

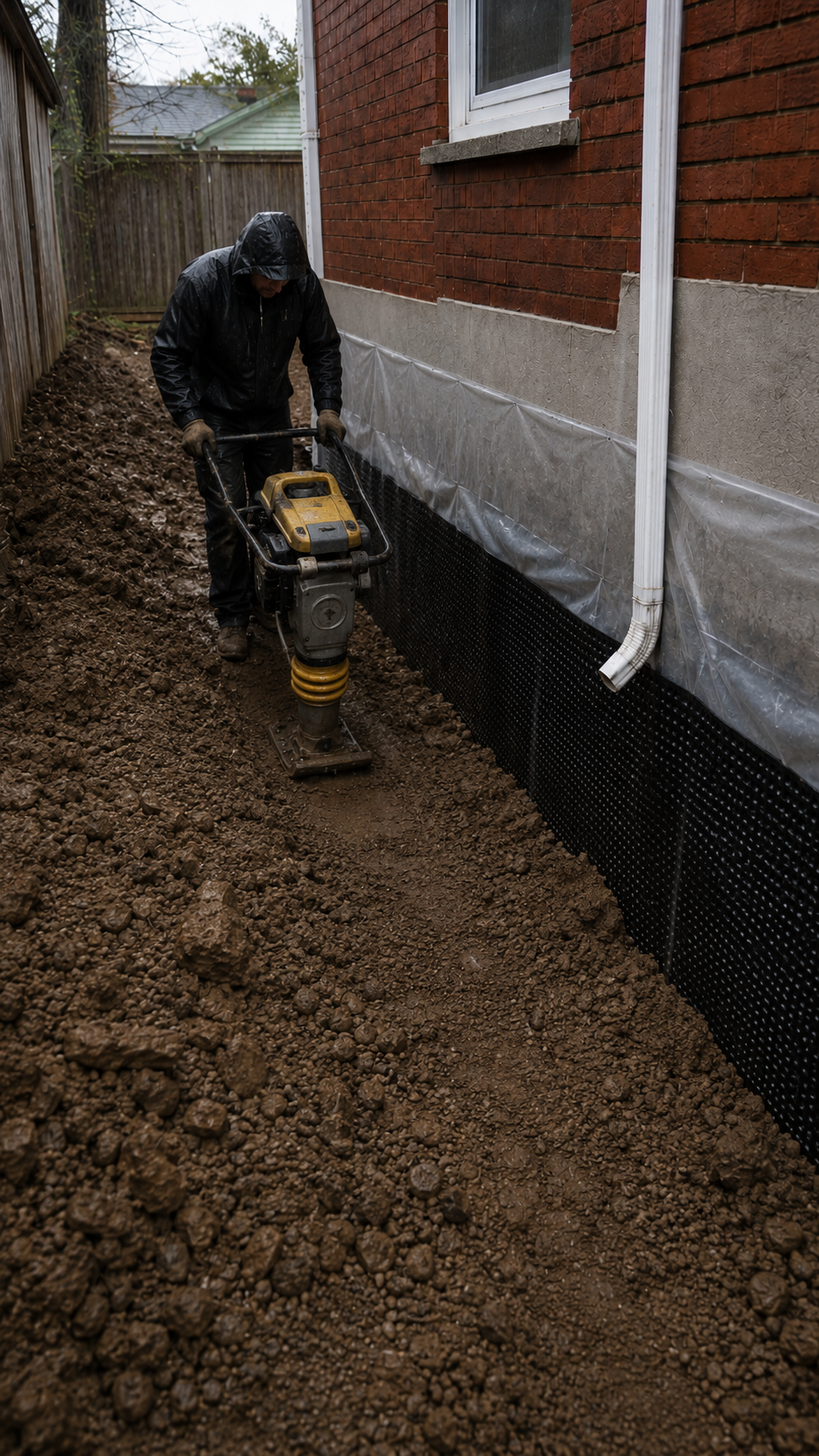

Soil being tamped during backfill every 2 feet
Continued soil compaction during backfill process
12Poly LayerDay 8

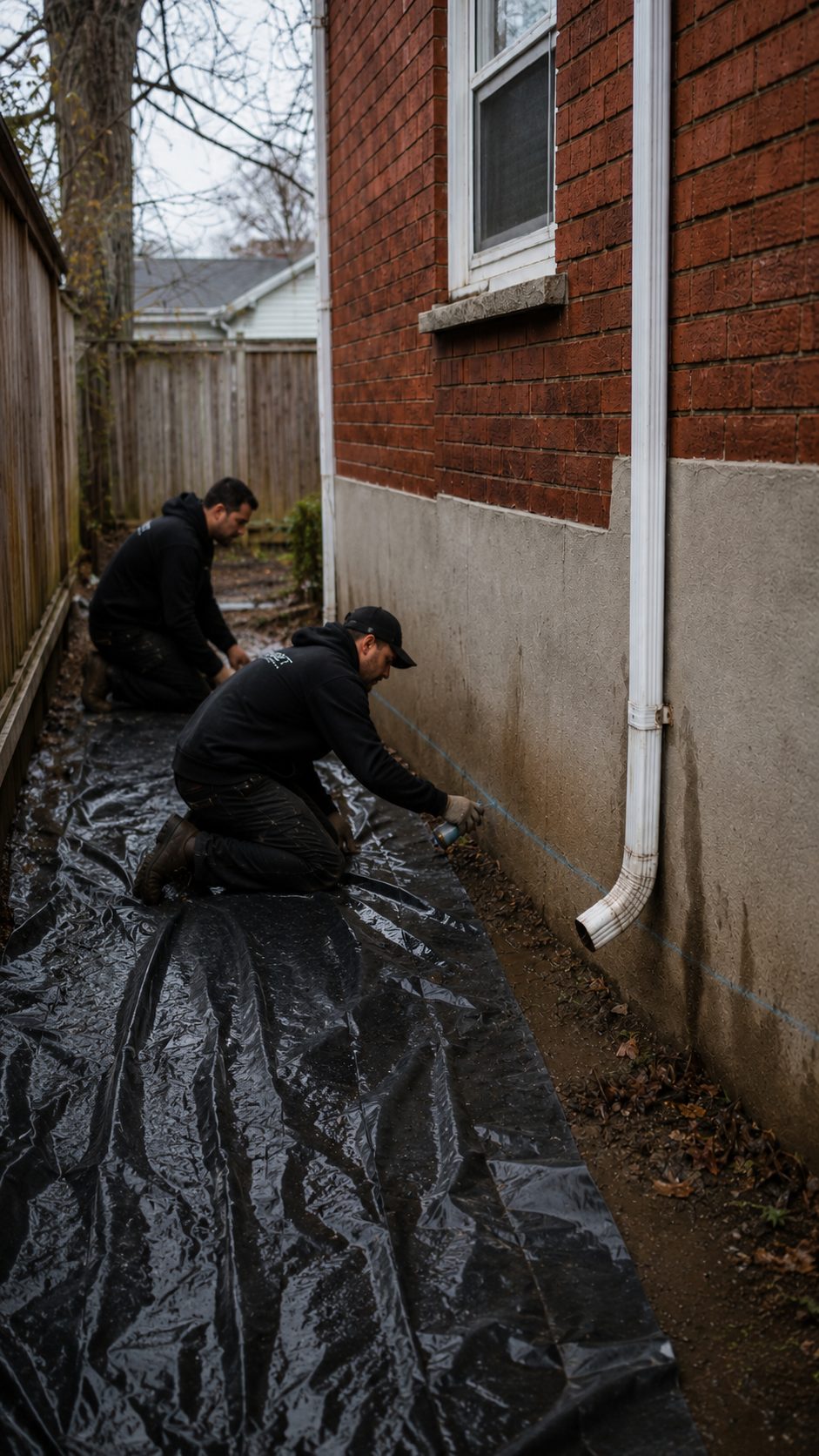

Install Poly Layer

A polyethylene barrier is placed over the compacted backfill near the surface. This extra layer prevents surface water from percolating down to the foundation, directing it laterally away from the house.

Poly layer installed over compacted backfill

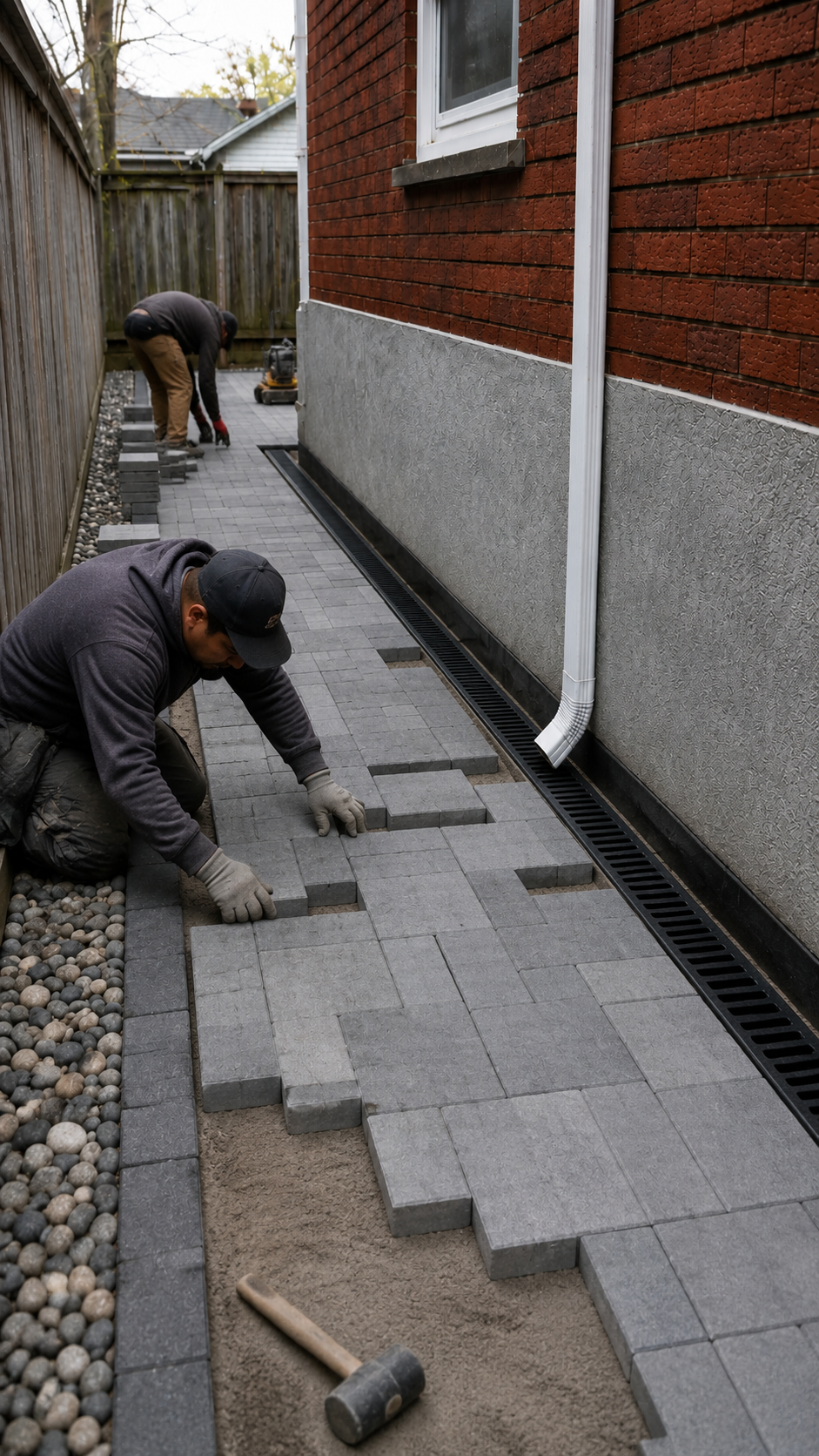

13InterlockDay 8

Interlock with Drainage Tile

The surface is finished with interlocking pavers or stone, incorporating a drainage tile underneath. This creates a clean, functional surface that directs water away from the foundation while providing a finished look.

Interlocking pavers installed with drainage tile underneath
14CompleteDay 8 — Project complete

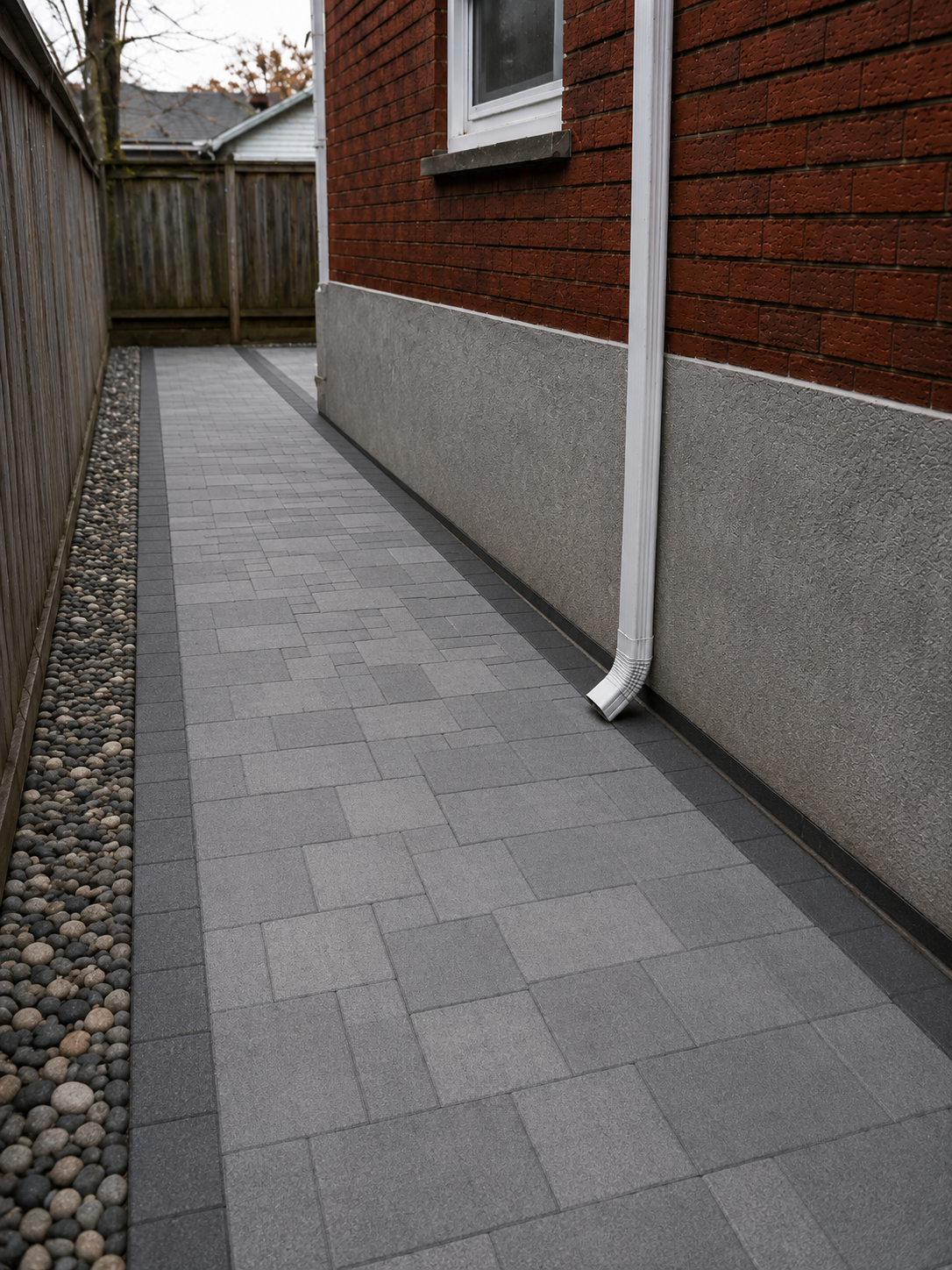

Final Result — Dry Basement

The exterior waterproofing is complete. The foundation is protected by multiple layers: liquid membrane, poly vapor barrier, dimpled membrane, weeping tile, and gravel drainage — a comprehensive system that keeps your basement dry for decades.

Completed exterior waterproofing project with dry basement

Frequently Asked Questions

How long does exterior waterproofing take?expand_more
A typical residential exterior waterproofing project takes 6–8 working days. This includes 1 day for inspection, 2–3 days for excavation, 1–2 days for membrane and drainage installation, and 2–3 days for backfill and finishing.
What is the difference between interior and exterior waterproofing?expand_more
Interior waterproofing manages water after it enters the basement (weeping tile, sump pump, dimpled membrane inside). Exterior waterproofing stops water before it reaches the foundation wall by applying membrane, drainage, and gravel on the outside. Exterior is more comprehensive but requires excavation.
How much does exterior waterproofing cost in Toronto?expand_more
Exterior waterproofing for a typical Toronto house ranges from $8,000 to $25,000+ depending on the length of wall being treated, depth of excavation, soil conditions, and access difficulty. Full-perimeter waterproofing costs more than spot-treating one wall.
Do I need a permit for exterior waterproofing?expand_more
In most Ontario municipalities, exterior waterproofing alone does not require a building permit. However, if the work involves changes to grading, drainage connections to municipal systems, or structural repairs, a permit may be required. Check with your local building department.
What is a dimpled membrane and why is it important?expand_more
A dimpled membrane is a high-density polyethylene (HDPE) sheet with raised bumps (dimples) that create an air gap when installed against the foundation wall. This air gap channels water down to the weeping tile, protects the liquid membrane from backfill damage, and provides a thermal break.
How long does exterior waterproofing last?expand_more
A properly installed exterior waterproofing system lasts 25–50+ years. The liquid membrane, dimpled membrane, and weeping tile are all designed for long service life. The most common failure point is clogged weeping tile, which is why filter fabric and proper gravel are essential.
What is weeping tile and how does it work?expand_more
Weeping tile is a perforated 4-inch pipe installed at the base of the foundation footing. Groundwater seeps through the perforations and is carried away from the foundation by gravity. It’s wrapped in filter fabric to prevent soil and sediment from clogging the perforations over time.
Can I waterproof just one wall instead of the whole foundation?expand_more
Yes. If only one wall shows signs of water infiltration, you can waterproof just that section. This is called spot or partial waterproofing and costs significantly less than full-perimeter treatment. However, if multiple walls are affected, full-perimeter is more cost-effective long term.
Why is soil compaction important during backfill?expand_more
Without proper compaction in 2-foot lifts, the backfill soil settles over time and creates a trench around your foundation. This trench collects rainwater and directs it straight to the foundation wall — exactly the problem waterproofing is supposed to solve. Compaction prevents this.
What causes basement water leaks in Toronto homes?expand_more
The most common causes are: hydrostatic pressure from high water tables, poor exterior grading that directs water toward the foundation, aging or deteriorated waterproofing membranes, clogged or collapsed weeping tile, and foundation cracks from settlement or frost heave.
