Basement Underpinning in Toronto

Lower your basement, gain full ceiling height, and unlock a legal second suite. Toronto underpinning costs $500–$800 per linear foot — a typical semi-detached project runs $75,000–$150,000 all-in, including engineering and permits.

Not ready? Check your price in 2 minutes

WSIB & OBC Licensed
Engineering & permits managed for you
Free walkthroughs, no obligation

Written by Pavel Vysotckii

BCIN-certified building designer & Quantity Surveyor · Updated June 2026

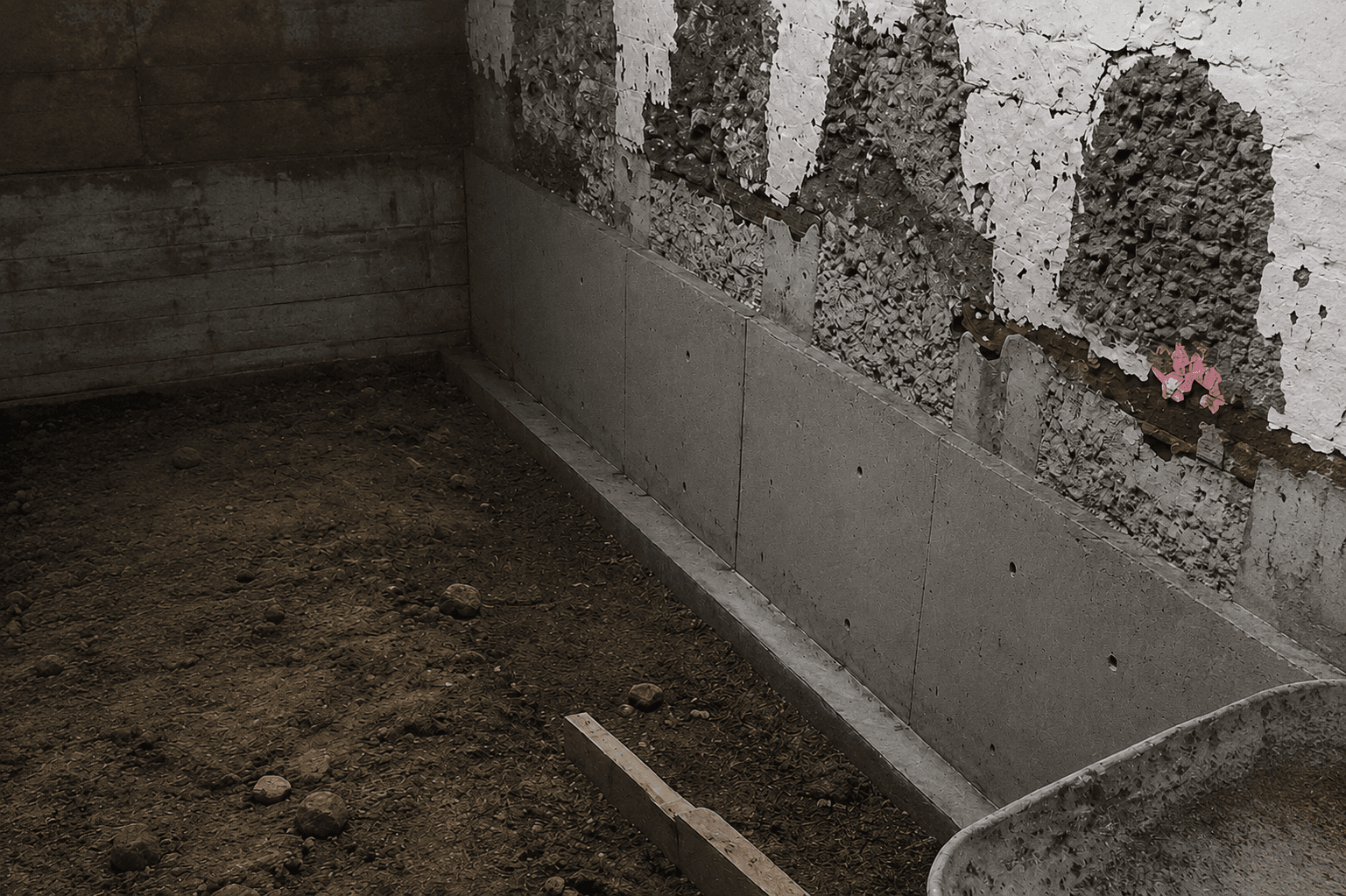

Basement underpinning in Toronto — excavation in progress

Underpinning proceeds in alternating 4-foot sections — never more than 25% of the foundation open at once.

Updated June 2026

What Does Basement Underpinning Cost in Toronto?

Prices below reflect 2026 Toronto market rates for homes in the City of Toronto proper. Final cost depends on perimeter length, target depth, soil conditions, and access constraints (narrow lots, mature trees, party walls).

Bench Footing
$300 – $500
per linear foot

Loses 12–18" of floor space per wall. Best when budget is the priority.

Mass-Concrete Underpinning
$500 – $800
per linear foot

Full floor plan preserved. Required for legal basement apartments.

Full Project (Typical Semi)
$75,000 – $150,000
total all-in

~130 lf perimeter, with engineering and permits (~$5K–$12K combined) included.

Typical Total Cost by Starting Ceiling Height

Based on a standard 25 × 40 ft Toronto semi-detached (~130 lf perimeter). Includes engineering, permit, drainage, and slab.

Starting height 5'6" – 5'10"
$90,000 – $150,000
Target height
7'6" – 8'0"
Depth added
22 – 30"
Common in
Victorian/Edwardian, The Annex
Starting height 5'10" – 6'4"
$75,000 – $120,000
Target height
7'6"
Depth added
14 – 20"
Common in
Interwar (1920s–40s), Danforth, Leslieville
Starting height 6'4" – 6'8"
$75,000 – $100,000
Target height
7'6"
Depth added
10 – 14"
Common in
Post-war (1950s–60s), East York, Etobicoke

Engineering + Permit Costs

Geotechnical soil report ($1,500–$3,500) + structural engineering drawings ($2,500–$6,000) + Toronto Building permit ($1,000–$2,500) = combined soft costs of $5,000–$12,000 — already counted in the all-in ranges above.

Access Premiums

Narrow side yards (under 4 ft) requiring hand excavation add $8,000–$15,000. Mature tree root management adds $2,000–$5,000. Rubble stone foundation reinforcement adds 15–25% to base costs.

City of Toronto Subsidy

Underpinning Is the Cheapest Moment to Flood-Proof Your Basement

During underpinning, the old slab is already broken out and new drainage is going in — so adding a backwater valve and sump system costs a fraction of retrofitting them later. The City of Toronto's Basement Flooding Protection Subsidy reimburses eligible homeowners up to $6,650 for this work (for work completed on or after November 12, 2025).

We plan the valve and sump locations into the underpinning drawings, so the flood-protection work happens while the slab is open instead of as a second dig.

What the subsidy covers

  • Backwater valveUp to $1,600

    Per device, maximum 2 devices

  • Sump pumpUp to $2,250

    Plus $300 for a battery backup

  • Foundation drain pipe severance & cappingUp to $400
  • Plumbing investigationUp to $500
Maximum total subsidy$6,650

Amounts apply to work completed on or after November 12, 2025. Verified June 2026 — see toronto.ca for current eligibility rules.

Want a number for your house? Book your walkthrough or call (437) 545-0067

Book your walkthrough

Who Does the Work

RenoNext is the contractor on site — not a directory or referral service. Our founder is a BCIN-certified building designer and Quantity Surveyor, so the structural drawings, permit submissions, and cost estimates behind your project are reviewed in-house.

Licensed under the Ontario Building Code
Insured and WSIB covered
Fixed milestone pricing — agreed before work starts
Free walkthroughs across Toronto & the GTA
Meet the founder and see our credentials

Follow every pour from your phone

Every underpinning project runs on our live client app. You see daily photos of each section pour, inspection reports shared in the app the day they happen, spend vs budget in real time, and milestone approvals before any payment is released.

Underpinning happens below your floorboards — the app means you never have to wonder what is going on down there.

The Underpinning Process in 6 Phases

Basement lowering in Toronto is done in alternating 4-foot sections under a Toronto Building permit — your home stays structurally supported and you stay living in it throughout the 8–16 week process.

Here is what happens from permit application to final inspection.

01

Engineering & Permits

A structural engineer designs the underpinning layout and section sequence. A geotechnical engineer produces a soil report. Toronto Building reviews and issues a permit — typically 4–8 weeks.

02

Site Preparation & Shoring

The basement is cleared and the foundation wall is marked into alternating 4-foot sections. Temporary shoring is installed to support floor loads while sections are being excavated.

03

Alternating Excavation

Odd-numbered sections are excavated first — hand-digging beneath the existing footing to the new depth. No two adjacent sections are ever open simultaneously, keeping your home structurally supported at all times.

04

Forming & Concrete Pours

Each excavated section is formed, rebar is placed (inspected by Toronto Building), and 25–32 MPa concrete is poured. The section cures for 7+ days before the crew moves to even-numbered sections and repeats.

05

Drainage, Slab & Waterproofing

New weeping tile and a sump system are installed. A reinforced concrete floor slab is poured at the lower elevation with a vapor barrier. Exterior waterproofing membrane is applied if the wall was exposed.

06

Final Inspection & Backfill

Toronto Building performs the final inspection; your engineer issues a compliance letter. Exterior excavations are backfilled with granular material, graded to drain away from the foundation.

See the full 26-step visual guide

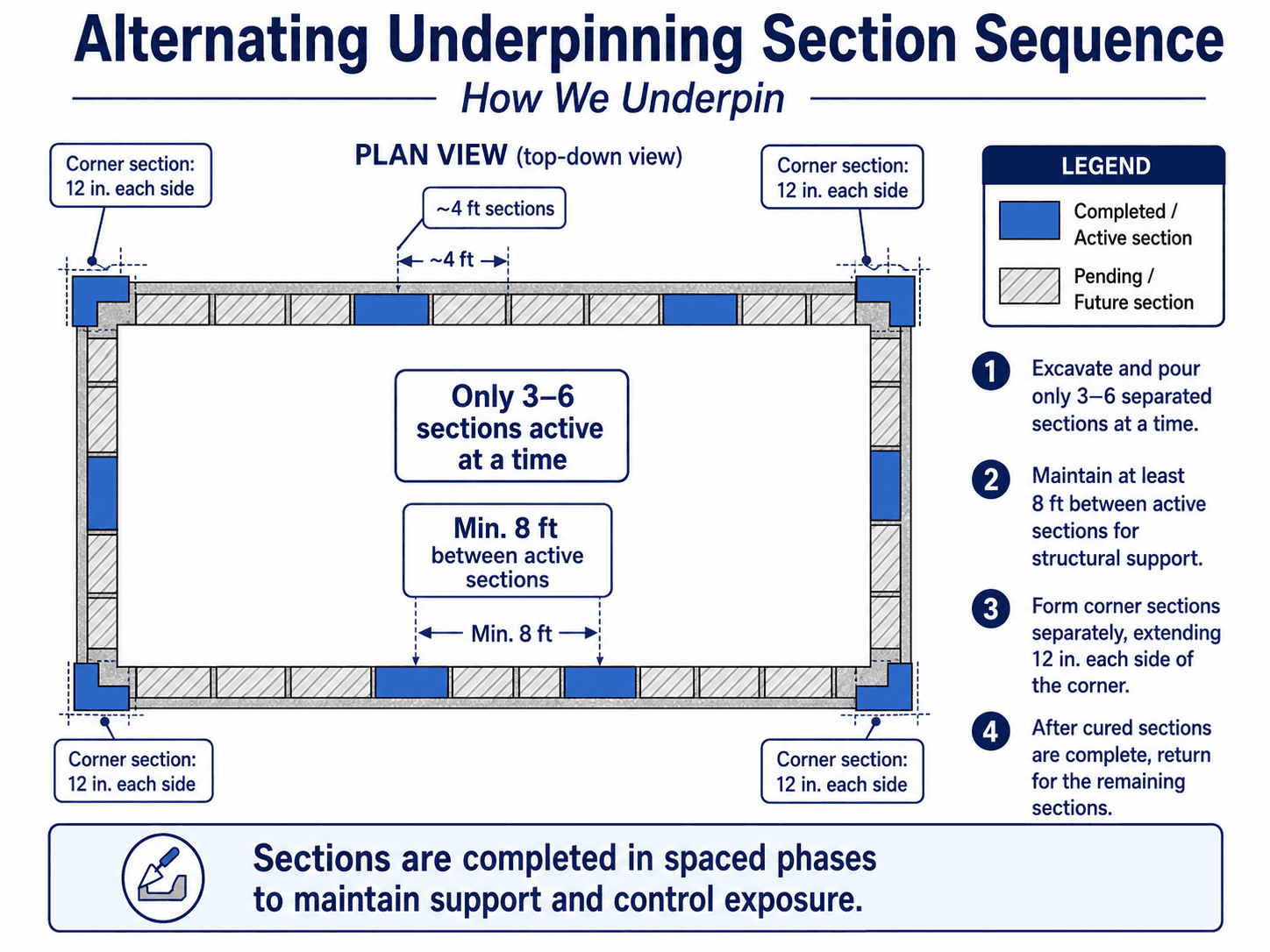

Alternating section underpinning sequence diagram — Toronto

Why alternating sections?

No more than 25% of the foundation perimeter is ever open at once. Odd-numbered sections cure to full strength before even-numbered sections are excavated. This is the code-required approach in Ontario — not optional, not a style choice. It keeps your home safe and your neighbors' properties unaffected.

8–16 wks
Construction time
5
Mandatory inspections

Questions about your house?

Free walkthroughs across Toronto & the GTA — no obligation.

(437) 545-0067
Required by Ontario Building Code

Toronto Underpinning Permits: What You Need

Underpinning is classified as a structural alteration. Toronto Building will not allow construction to start without a valid building permit — and for good reason. Here is what is required.

Geotechnical Soil Report$1,500 – $3,500

Soil classification, bearing capacity, water table depth.

Structural Engineering Drawings$2,500 – $6,000

Stamped by Ontario P.Eng. Shows section sequence, rebar, and concrete specs.

Shoring PlanIncluded in engineering

Temporary support system for adjacent soil and structure.

Commitment to General ReviewIncluded in engineering

Engineer pledges field reviews at each inspection stage.

Building Permit Application$1,000 – $2,500

Filed with Toronto Building; triggers plan examination.

Permit Timeline at a Glance

Weeks 1–4

Engineering & Soil Report

Week 4–5

Application Submitted to Toronto Building

Weeks 5–7

Plan Examination

Weeks 7–8

Revisions (if required)

Weeks 8+

Permit Issued — Construction Starts

Plan ahead: If you want to start construction in April or May, begin your permit application in January. Spring is the busiest season; late applications push your start date into summer.

Questions about permits for your house? Call (437) 545-0067 — we manage the drawings, application, and inspections for you.

Why Toronto Homeowners Underpin

With Toronto home prices averaging $1M+ for a semi-detached, underpinning is one of the highest-ROI renovations available. Here are the four most common goals.

Legal Basement Apartment

Toronto's Second Suite Bylaw allows basement apartments in most residential zones — but your ceiling must reach a minimum 6'5" (ideally 7'6"+ for marketable rents). Underpinning unlocks $1,800–$2,600/month in rental income. At $2,200/month average, a $100,000 underpinning project breaks even in roughly 4.5 years through rent alone.

Basement apartment underpinning guide

Second Suite / In-Law Suite

Multi-generational living is the fastest-growing reason for underpinning in Toronto. A self-contained in-law suite with a separate entrance, bedroom, bathroom, and kitchenette gives aging parents or adult children independence without leaving the property. Property value typically increases $100,000–$250,000 with a compliant second unit.

Second suite underpinning guide

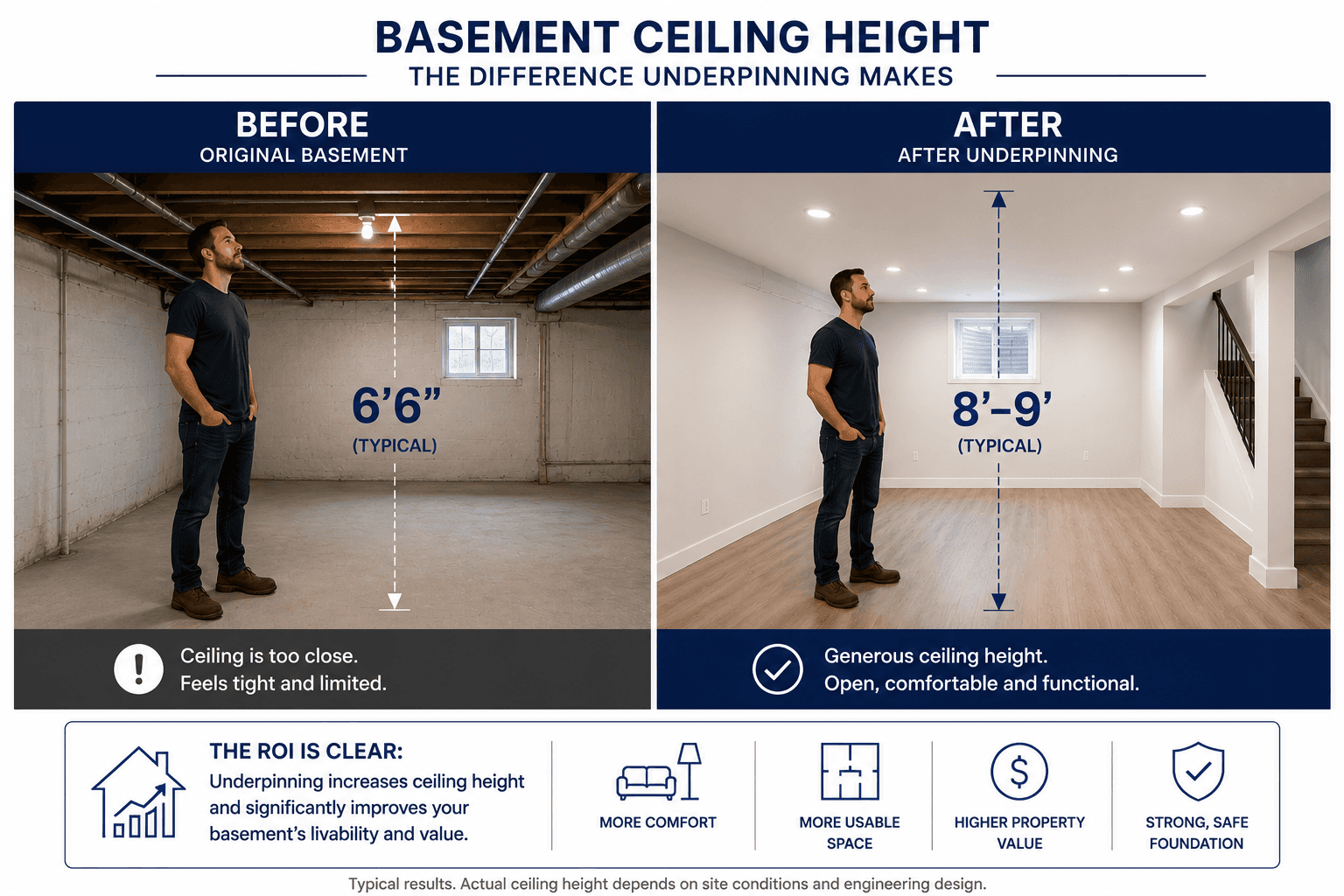

Basement ceiling height before and after underpinning in Toronto

From Unusable Cellar to Full Living Space

Most pre-1960 Toronto homes — the 1920s semi-detached bungalows of East York, the Edwardian homes in Riverdale, the Victorian row houses of Leslieville — were built with basement ceiling heights of 5'6" to 6'4". These spaces were designed for coal storage and furnaces, not living.

Underpinning lowers the floor by 12–30 inches, bringing ceilings to 7'6"–9'0". The transformation is structural: new reinforced concrete footings at a lower bearing depth, a new floor slab, and a code-compliant space ready for finishing.

Ceiling height
5'6" – 6'4"
7'6" – 9'0"
Permitted use
Storage/utility
Legal living space

Underpinning vs Bench Footing: Which Is Right for You?

We use both methods — the right choice depends on your basement and budget. Here is the key tradeoff.

Mass-Concrete Underpinning

Excavates beneath the existing footing and pours new, deeper footings in alternating sections. No floor space is lost. The only method that fully preserves your floor plan — essential when you need every square foot for a rental apartment. Costs $500–$800/lf.

Bench Footing

Pours a concrete ledge against the inside of the foundation wall down to the new depth. Costs 30–40% less ($300–$500/lf) but loses 12–18 inches of floor width per wall. On a typical 25×40 ft Toronto semi, full-perimeter bench footing shrinks the basement by ~75 sq ft — the equivalent of a small bedroom. Best for budget-conscious projects or where one or two walls need lowering.

Full comparison guide with diagrams and cost examples

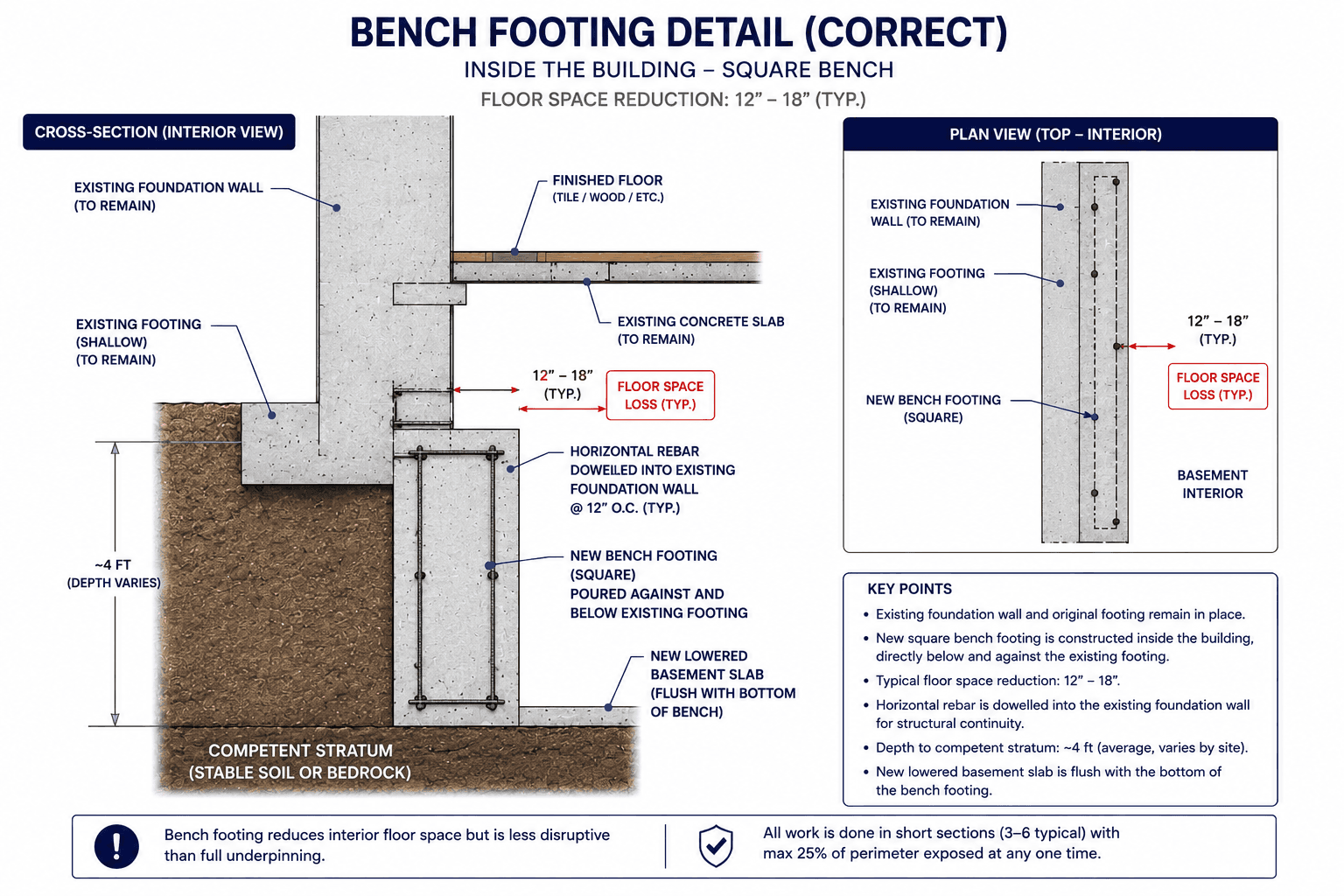

Bench footing cross-section diagram showing floor space lost

Quick Decision Guide

Maximizing livable area (rental apartment)Mass-concrete
Budget is the primary constraintBench footing
Only 1–2 walls need loweringBench footing
Full-perimeter lowering for 8'+ heightMass-concrete
Storage/mechanical room onlyBench footing

Frequently Asked Questions

Real questions from Toronto homeowners planning underpinning projects.

Bench footing costs $300–$500 per linear foot; mass-concrete underpinning costs $500–$800 per linear foot. A full basement lowering on a typical Toronto semi-detached (roughly 130 linear feet of perimeter) runs $75,000–$150,000 all-in — of that, about $5,000–$12,000 is engineering and permits. The final number depends on depth increase, home size, access constraints, and soil conditions.

Ready to Start Your Toronto Underpinning Project?

Book a free walkthrough with RenoNext — WSIB covered, OBC licensed, and experienced with Toronto's clay soil, century homes, and semi-detached party walls.

Not ready? Check your price in 2 minutes

Licensed & Insured

WSIB covered, fully insured, and licensed under the Ontario Building Code.

Toronto Expertise

Deep familiarity with Toronto clay soil, rubble stone foundations, narrow lots, and party wall requirements.

Watch your underpinning happen — from upstairs

Our live client app shares daily photos of each section pour, inspection reports, spend vs budget, and milestone approvals — so you always know what is happening below your floorboards.
