RenoNextRenoNext
CallBook your walkthrough
26-Step Visual Guide

From Old Basement
to Dream Space

Follow a real underpinning project through every phase — excavation, formwork, concrete, drainage, insulation, and finishing. 3 weeks, 26 steps, 34 photos, zero mystery.

Before: dark unfinished basement
Before

Dark, low-ceiling, unfinished

After: beautifully finished basement living space
After

Bright, warm, full-height living space

Written by Pavel Vysotckii

BCIN-certified building designer & Quantity Surveyor · Updated June 2026

Phase 1 of 5

Assessment & Mobilization

Day 1
1Before

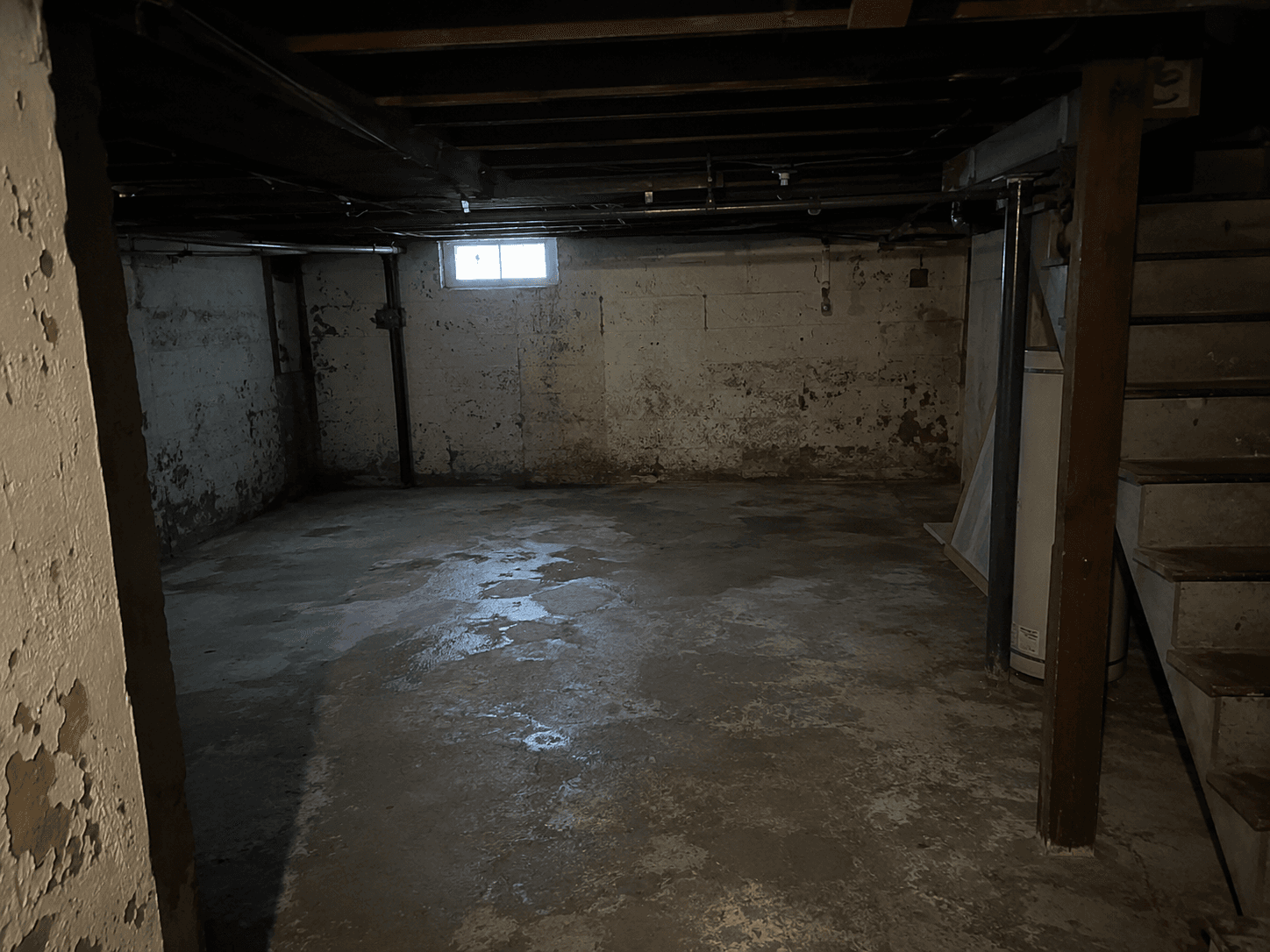

The Empty Basement

Every project starts here — a low-ceiling, unfinished basement with aging foundation walls, moisture stains, and limited headroom. This is the "before" that homeowners want to transform.

Empty unfinished basement before underpinning
2MobilizationDay 1

Crew & Equipment Arrive

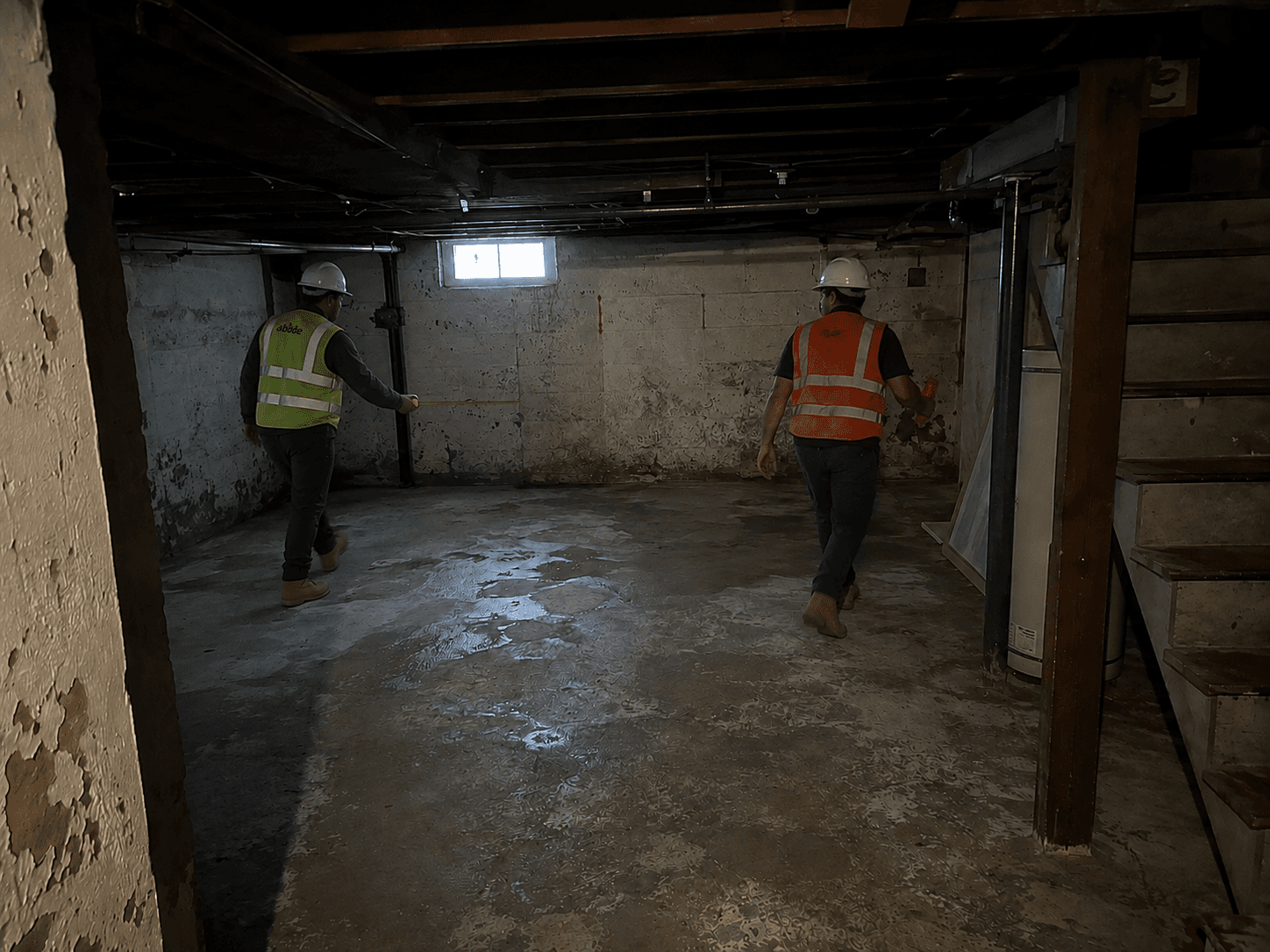

The contractor mobilizes to the site — tools, safety equipment, and materials are staged. Protective measures are set up to contain dust and debris.

Contractor crew mobilizing to the underpinning site

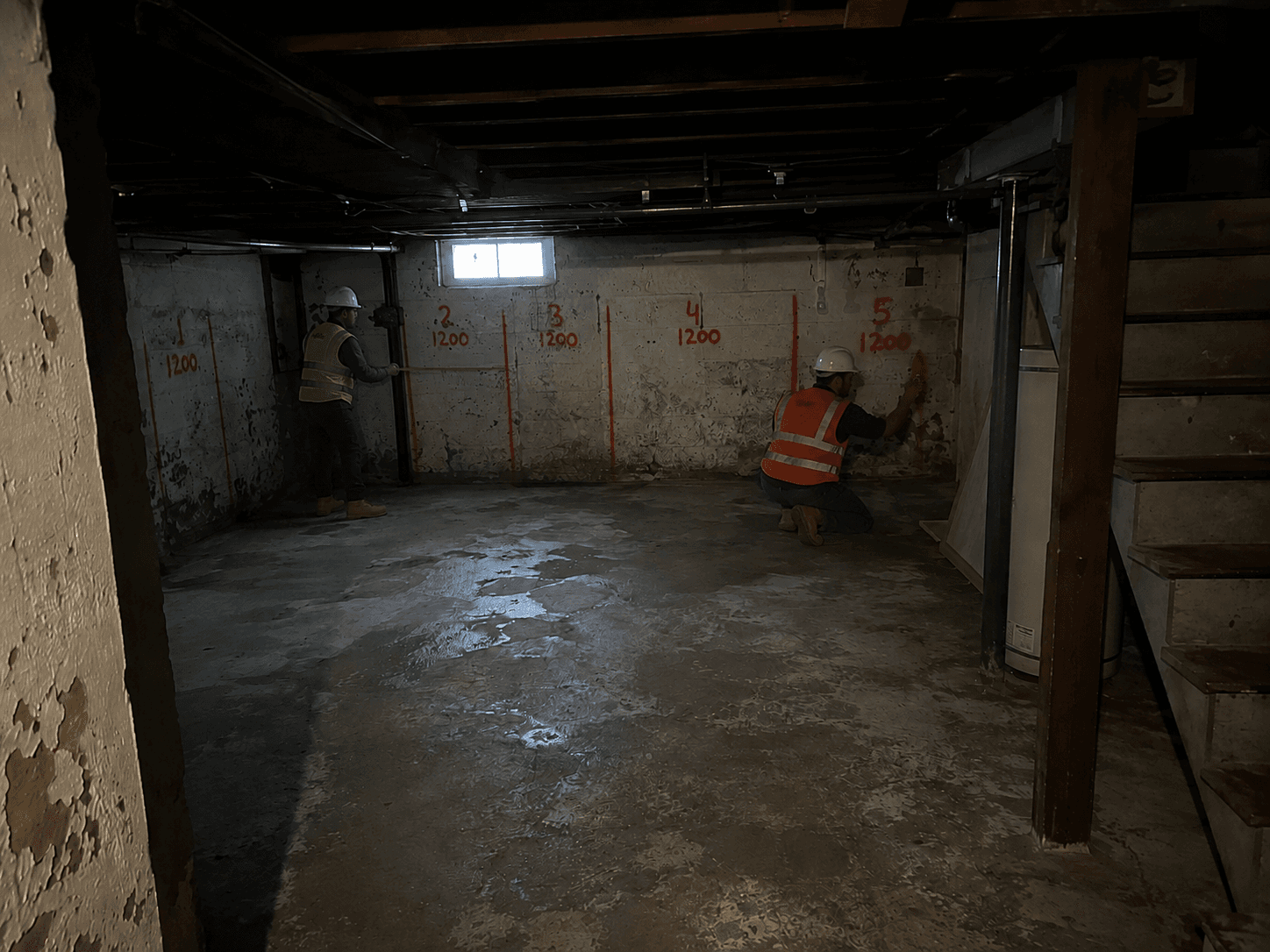

3LayoutDay 1

Section Marking (1200 mm Wide)

The foundation is divided into alternating sections, each 1200 mm wide. Sections are excavated one at a time to maintain structural integrity — never two adjacent sections simultaneously.

Sections are staggered to ensure the existing foundation is always supported on both sides of the active work zone.

Foundation wall marked in 1200mm underpinning sections

Phase 2 of 5

Excavation

Days 1–12
4DemolitionDay 1

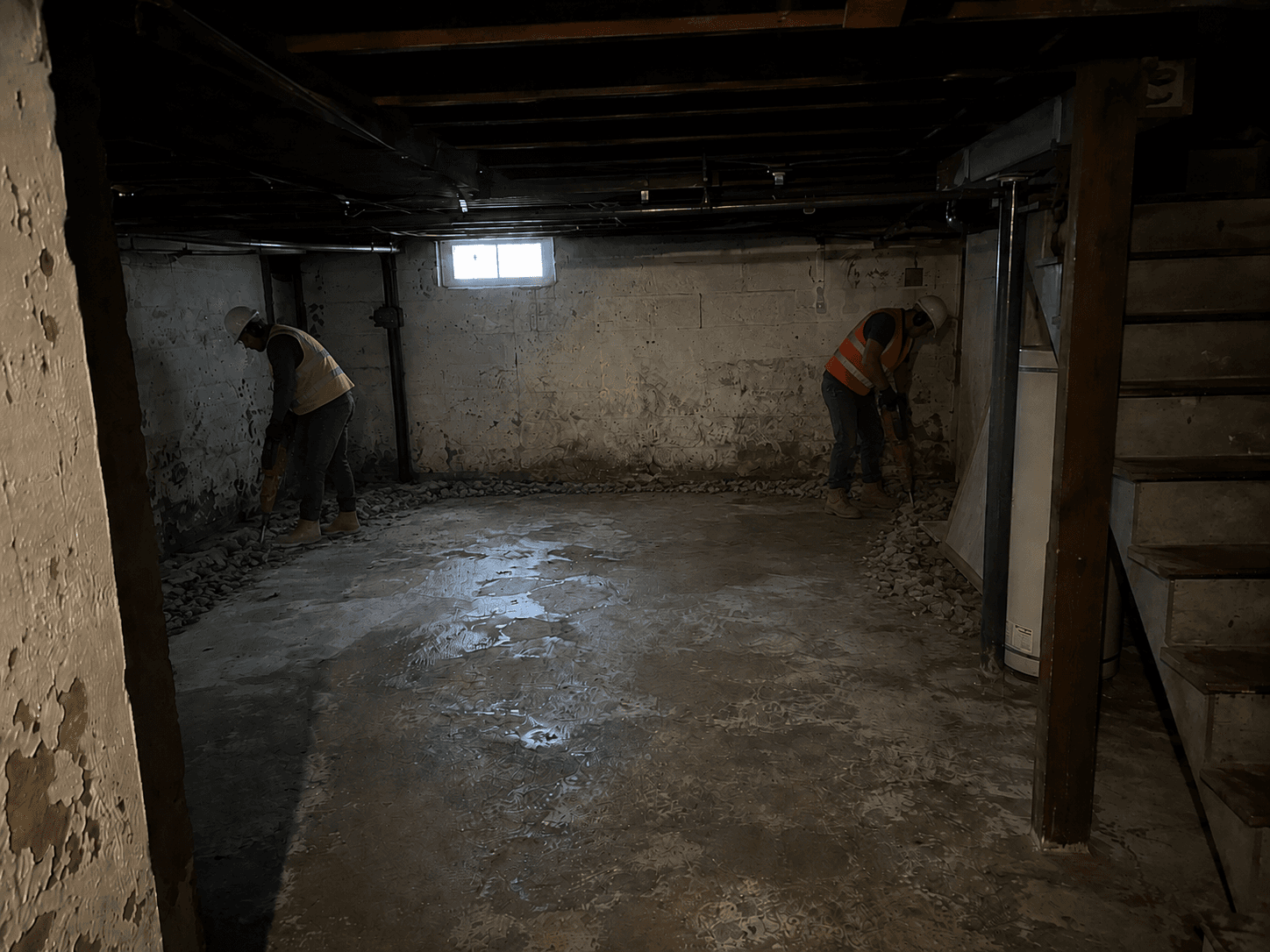

Break Out Existing Slab

The concrete floor slab is broken out at least 2400 mm away from the section being underpinned — giving safe working distance and room for excavation.

Demolition of existing concrete floor slab for underpinning
5Dig DownDay 1

Excavation to Required Depth

Each section is hand-excavated to the required depth — typically 4 feet below the existing footing. This is where the new, deeper foundation will be cast.

Depth is determined by the structural engineer based on soil conditions and desired ceiling height.

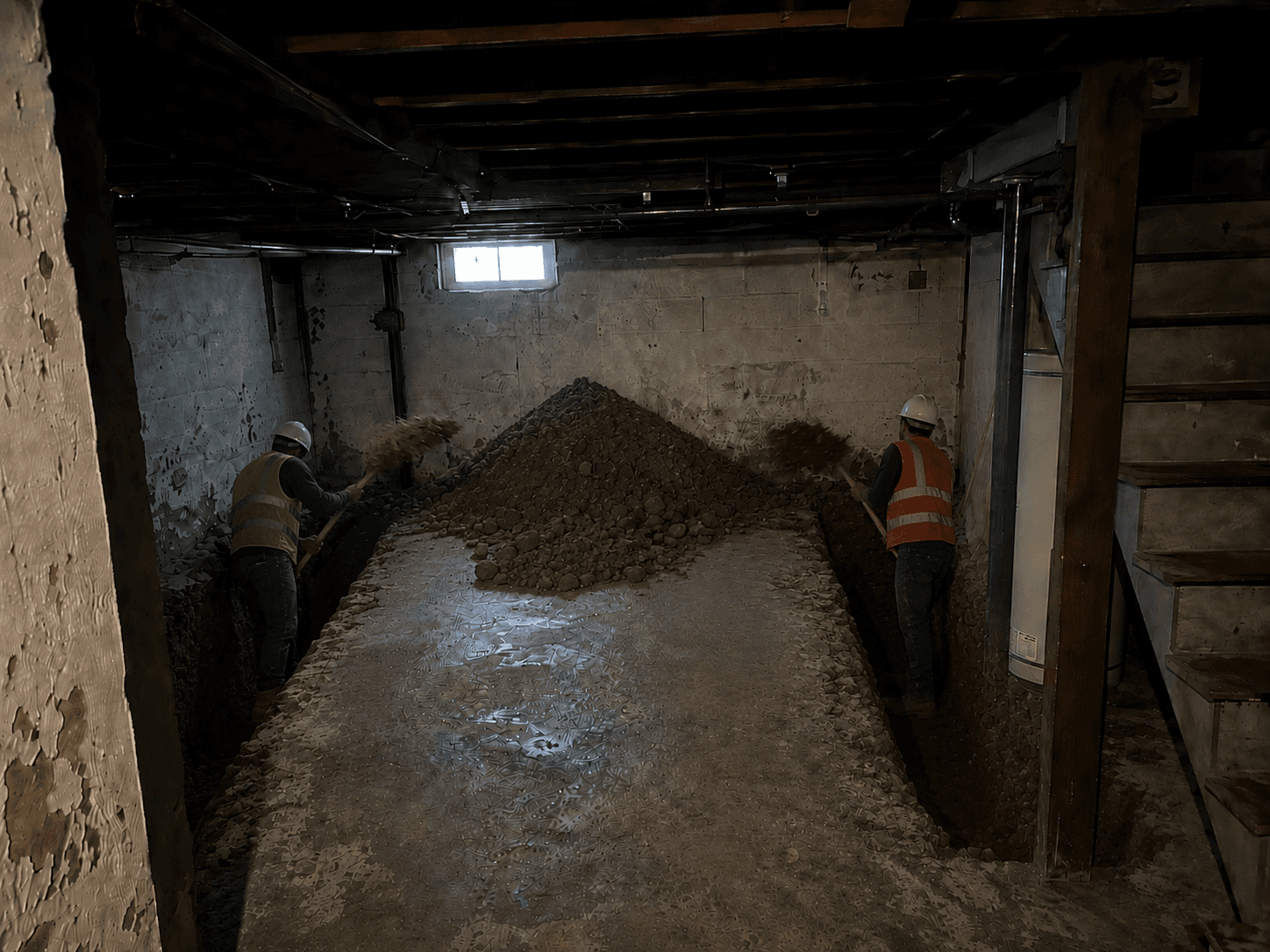

Excavation beneath foundation to required 4-foot depth
6Haul OutDays 1–12

Soil Removal

Excavated soil is removed from the basement — often through windows or an exterior opening. On tight urban lots, this is one of the most labour-intensive parts of the job.

Soil being removed through basement window during excavation
Excess soil removal from underpinning excavation

Phase 3 of 5

Underpinning — Section by Section

Week 1 & 2 — Days 1–12

We work 6 days a week. Each section is excavated one day, then poured the next. We alternate sections (1 → 4 → 2 → 5 → 3 → 6) so concrete has time to cure before the adjacent section is touched. This pattern repeats across 12 working days.

7FormworkExcavation day

Formwork Prep & Installation

Plywood and 2x4 lumber are cut to size and assembled into formwork that will shape the new concrete underpinning section. Forms are installed tight against the excavated soil and existing footing.

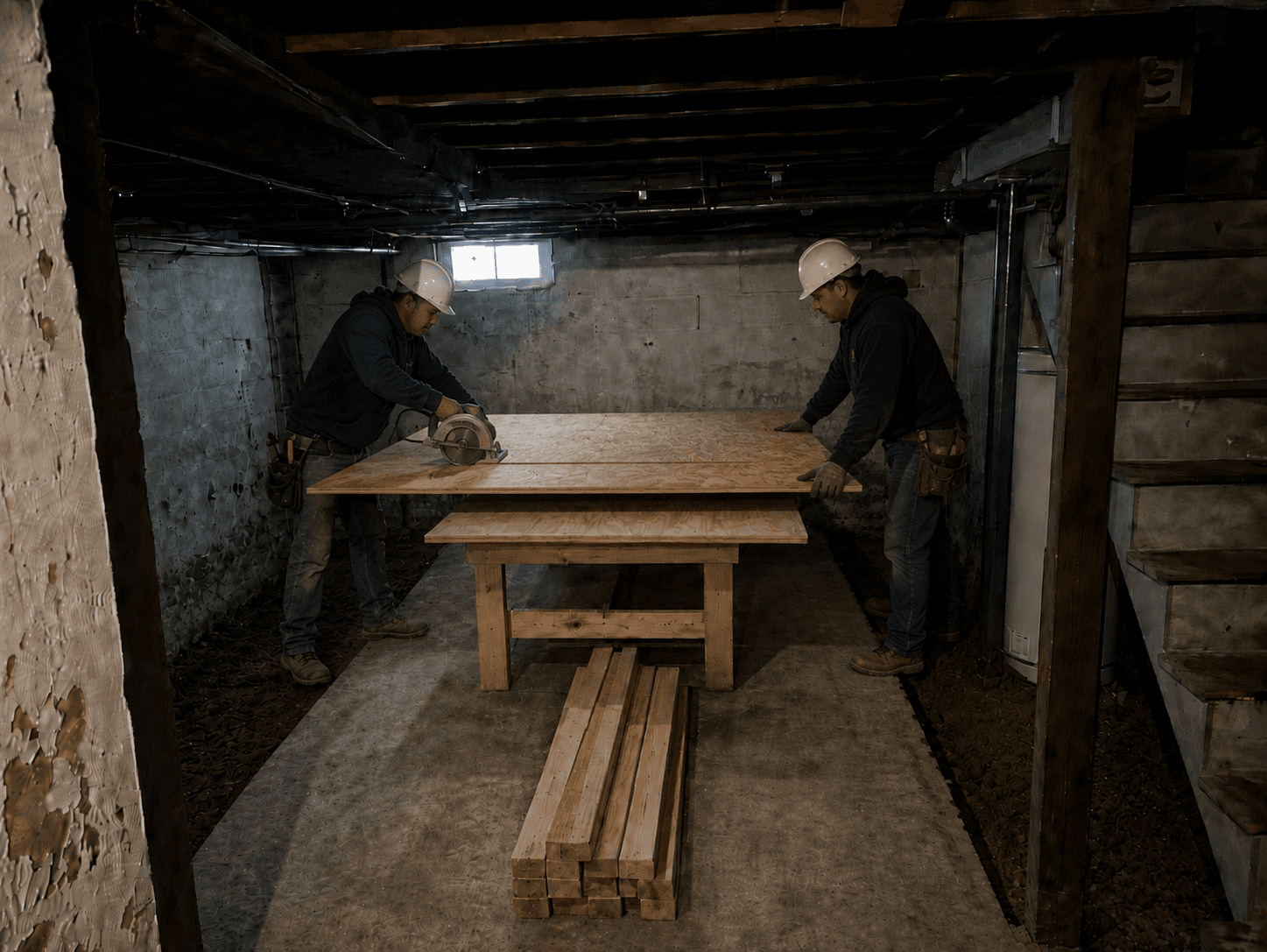

Plywood formwork being prepared for underpinning section
Formwork lumber cut and assembled
Formwork detail showing 2x4 bracing

Formwork installed in excavated underpinning section
8PourFollowing day

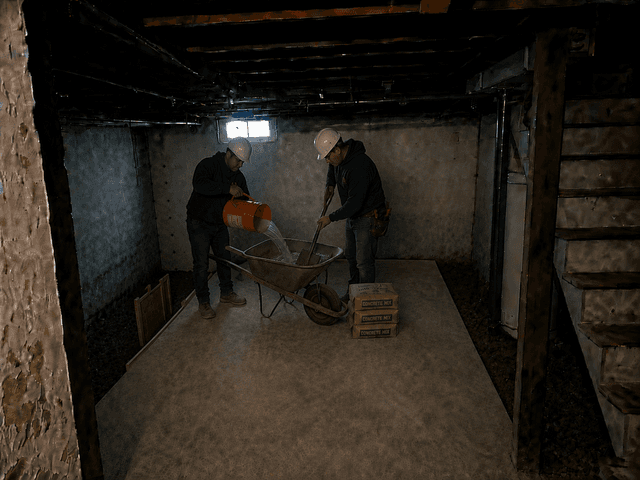

Concrete Mixing & Placing

Concrete is mixed on-site or delivered from a plant. It's placed into the formwork in lifts, vibrated to remove air pockets, and screeded level. Each section must cure before the adjacent one is excavated.

Typical cure time between sections is 48–72 hours, depending on mix design and temperature.

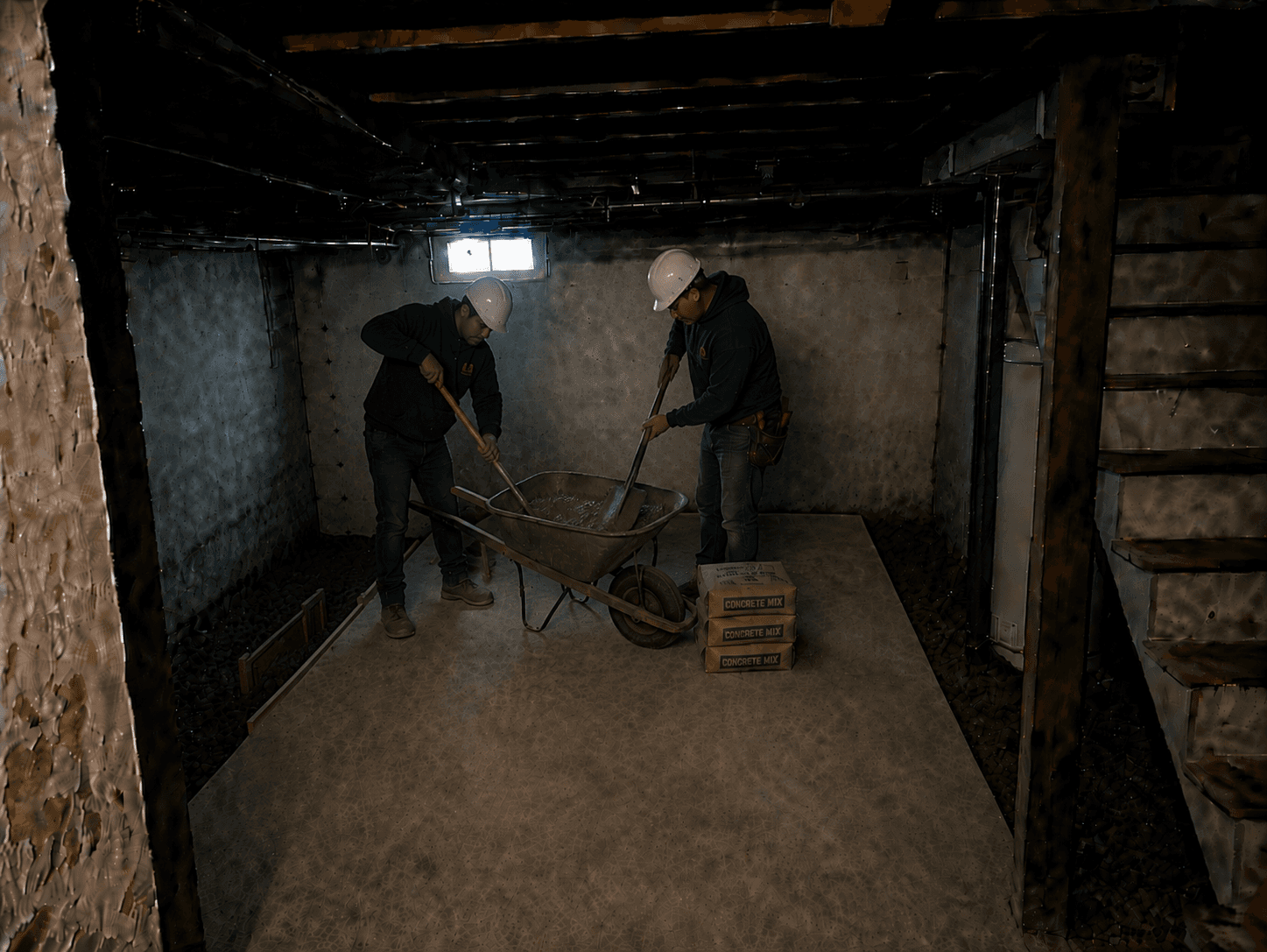

Concrete being mixed on-site for underpinning pour
Concrete supplied from ready-mix plant
Fresh concrete being placed into underpinning formwork

9CompleteDay 12 — End of Week 2

Underpinning Complete

All sections have been poured and cured. The foundation now extends to the new, deeper elevation. The basement has full headroom, and the walls are solid new concrete.

Completed underpinning with all sections poured and cured

Phase 4 of 5

New Slab & Drainage

Week 3 — Days 13–19

3 days slab removal, 2 days drainage, 2 days waterproofing and new slab. This wraps up the structural scope — in and out in 3 weeks for a typical Toronto house.

10Remove SlabDays 13–15

Old Slab Removal to Depth

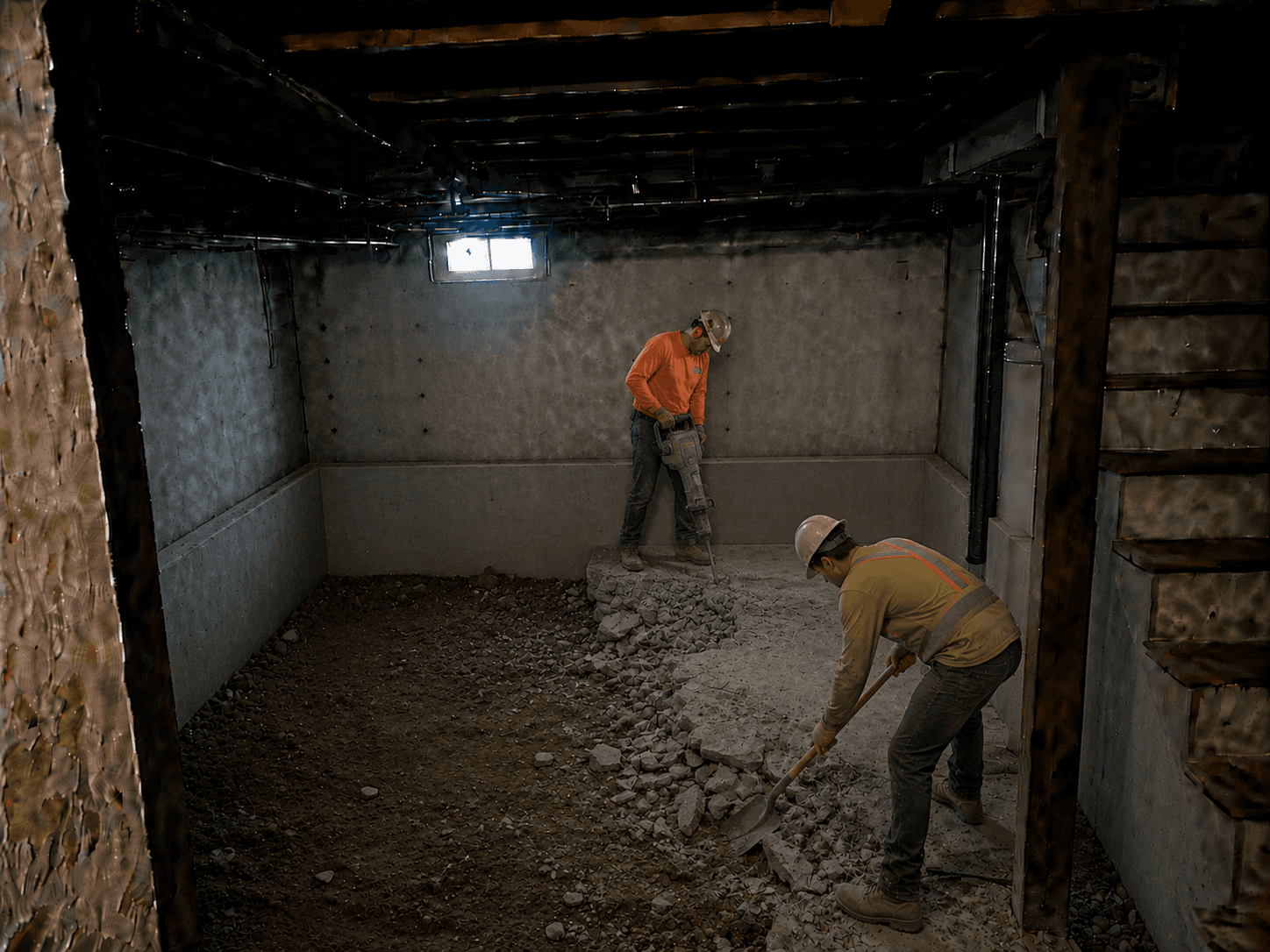

The remaining original concrete floor slab is broken out and removed to the specified depth, making way for proper drainage, insulation, and a new engineered floor system.

Removal of old concrete slab to specified depth
11DrainageDays 16–17

Perimeter Drain & Sump Pump

A new weeping tile (perimeter drain) system is installed around the inside of the foundation walls, sloped to a sump pit with a pump. This is the primary waterproofing defense.

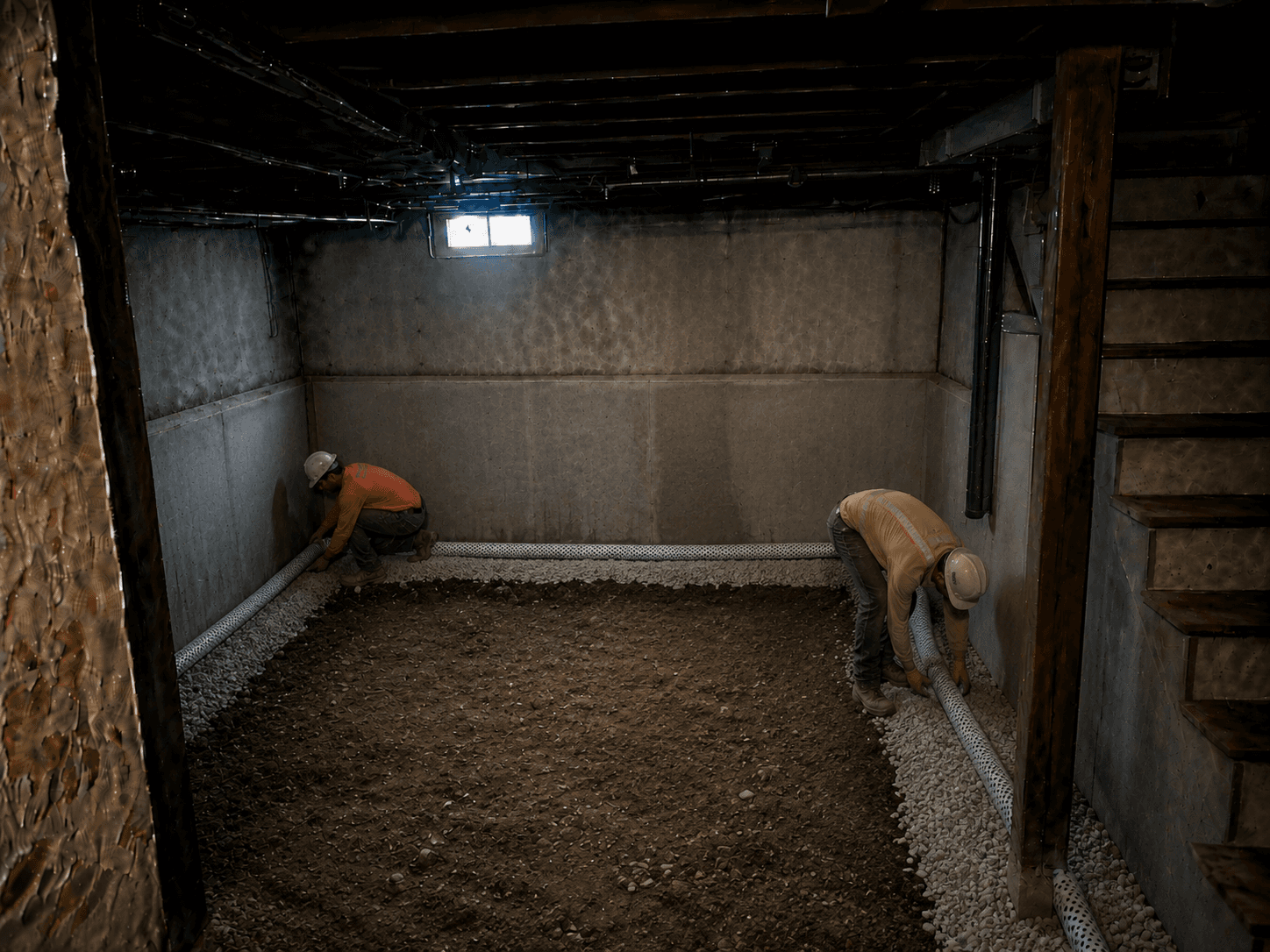

New perimeter drain tile and sump pump installation
12WaterproofingDay 18

Drains & Dimpled Membrane

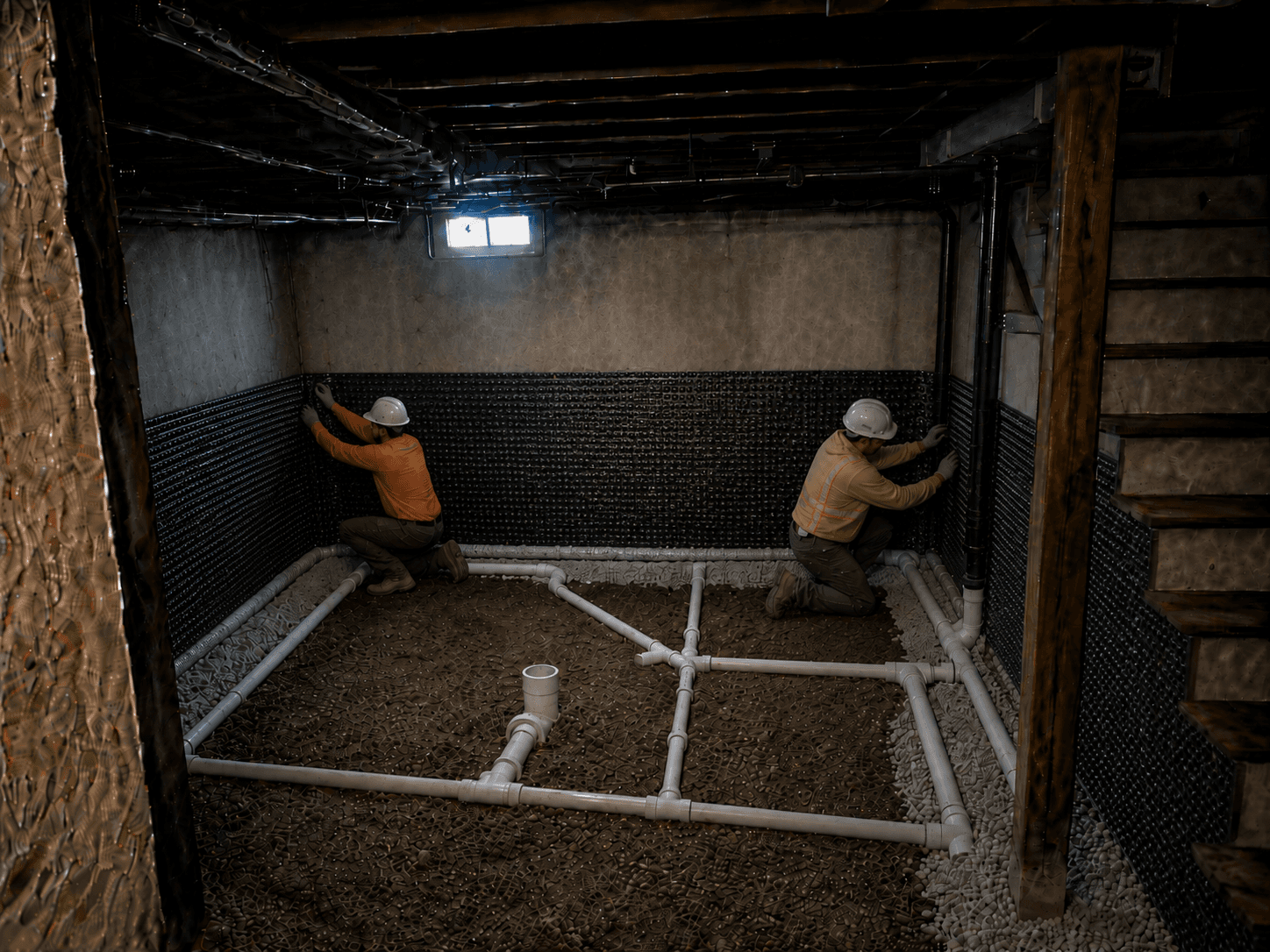

Drainage channels connect to the sump, and a dimpled membrane is applied to the foundation walls. The membrane creates an air gap that channels any residual moisture down to the drain.

Dimpled waterproofing membrane installed on foundation walls
13GravelDay 18

Gravel Base

Clean gravel is spread and compacted over the drainage system, providing a stable, free-draining base for the new floor slab.

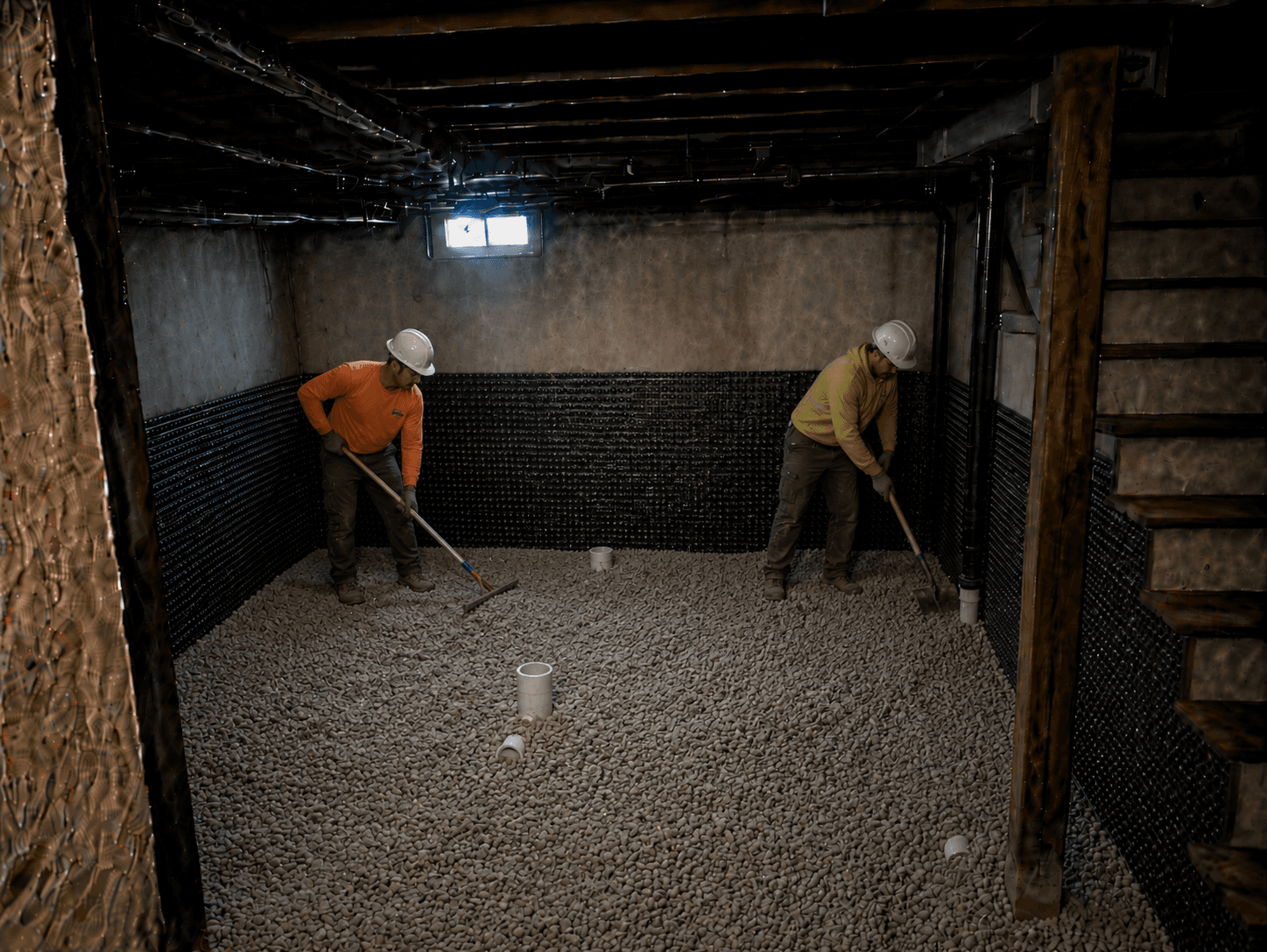

Compacted gravel base over drainage system
14Vapor BarrierDay 18

6 Mil Poly — Vapor & Radon

A 6 mil polyethylene sheet is laid over the gravel, sealing out moisture vapor and radon gas from the soil below. Seams are overlapped and taped.

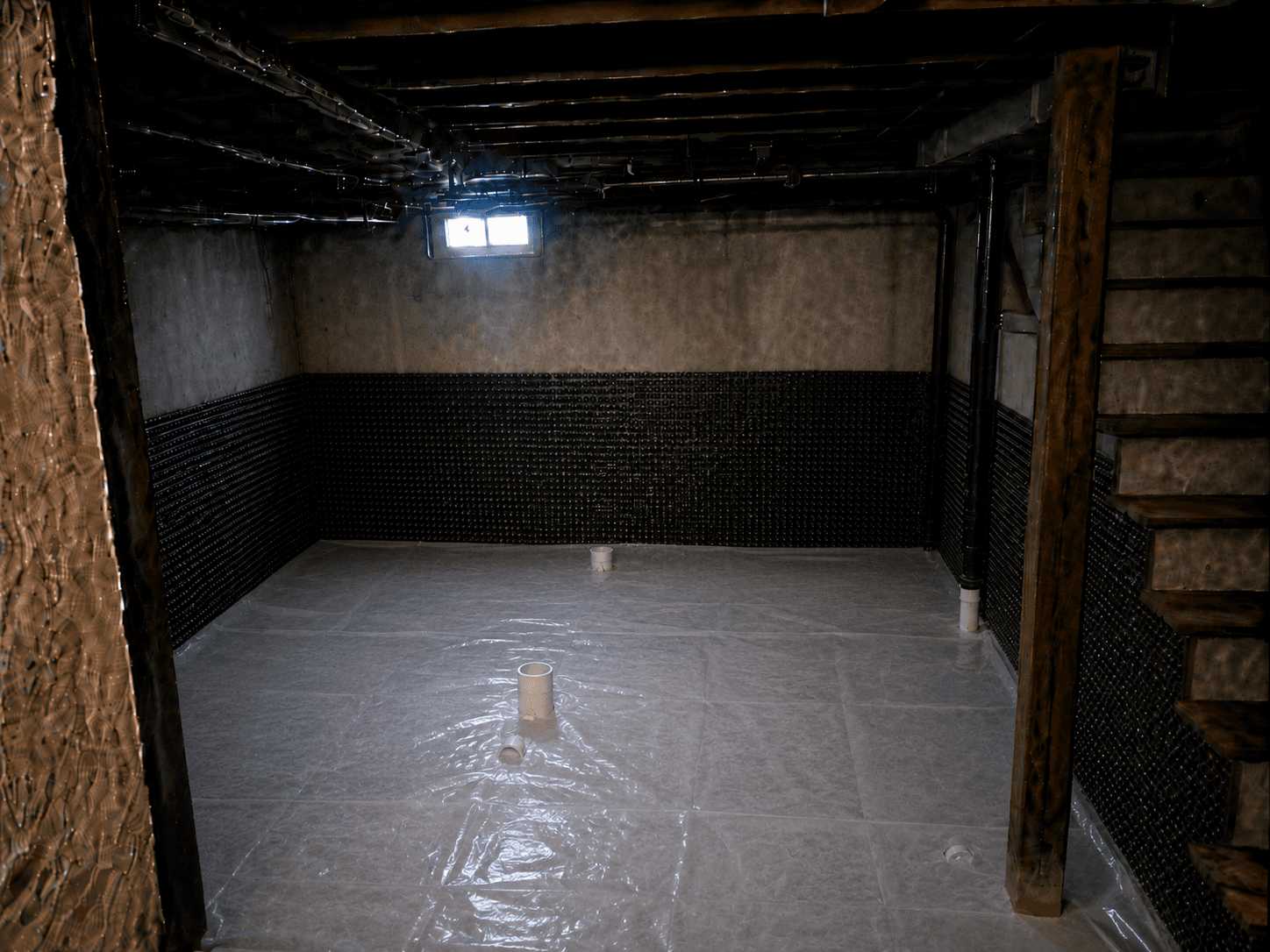

6 mil polyethylene vapor and radon barrier installed
15Radiant HeatDay 19

Heated Floor (In-Slab)

PEX tubing for in-floor radiant heating is laid out in a serpentine pattern on top of the vapor barrier. This will be embedded in the new concrete slab for efficient, comfortable heat.

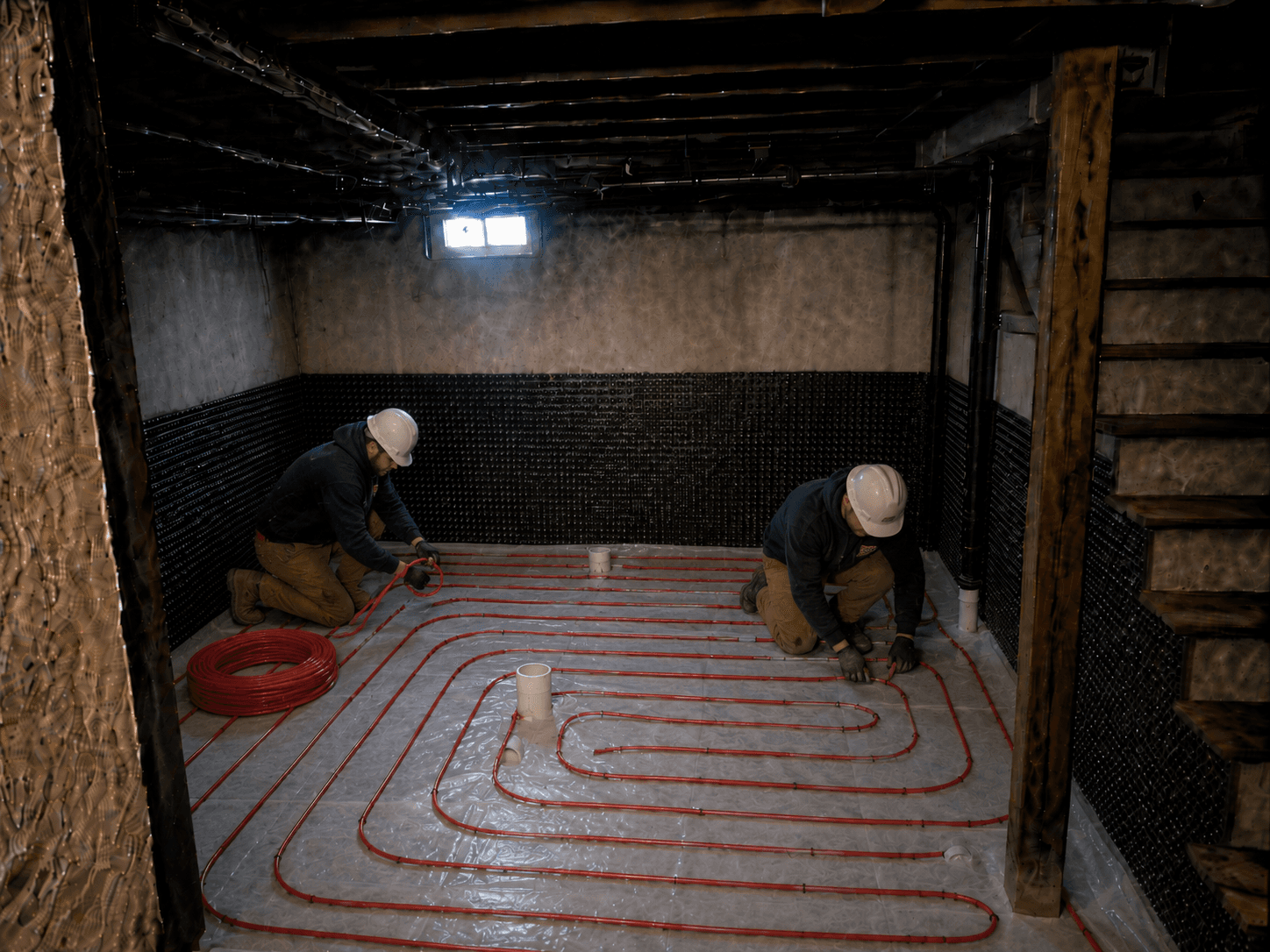

PEX radiant heating tubing laid out before concrete pour
16New FloorDay 19 — Structural complete

New Concrete Floor Slab

A new reinforced concrete floor slab is poured over the heated floor system. The surface is power-troweled to a smooth finish.

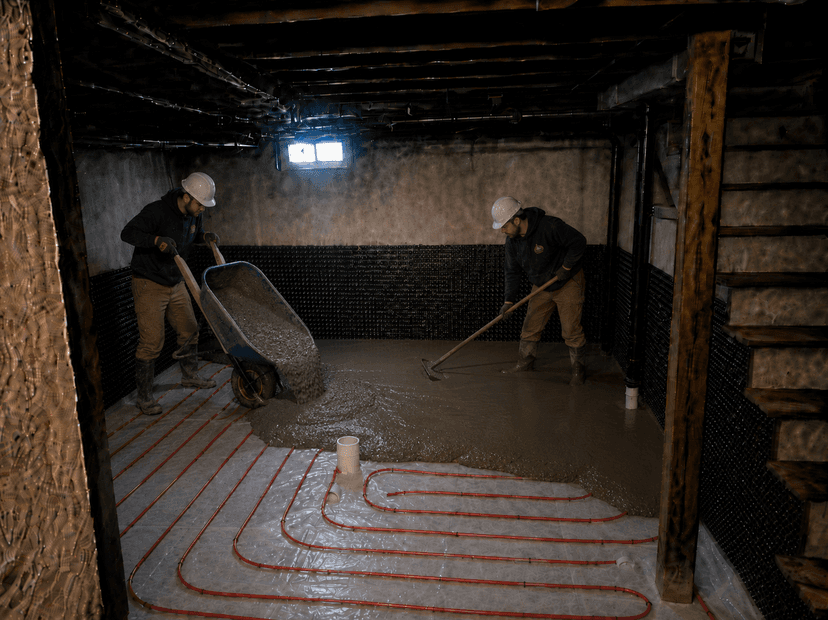

New concrete floor slab being poured

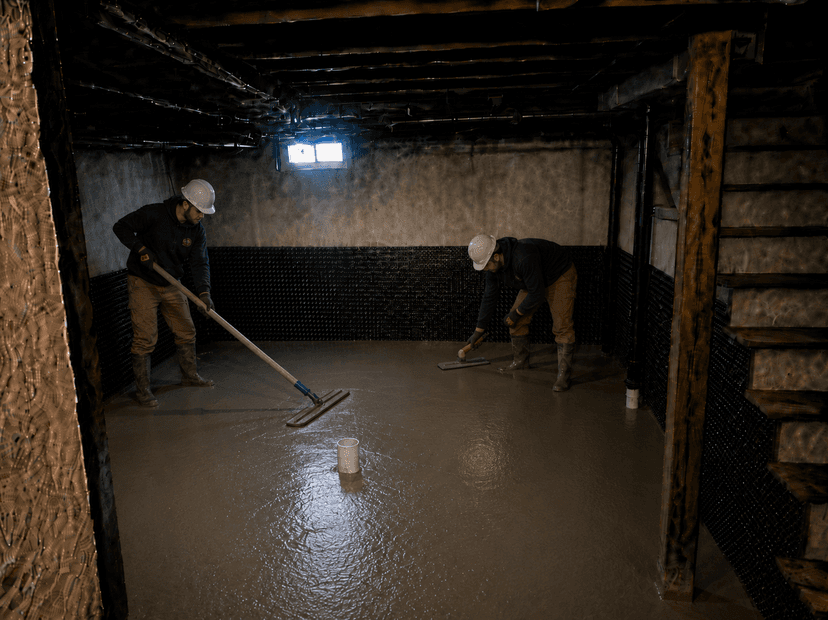

Finished concrete floor slab with smooth troweled surface

Phase 5 of 5

Finishing

After Week 3
17Egress

New Egress Window

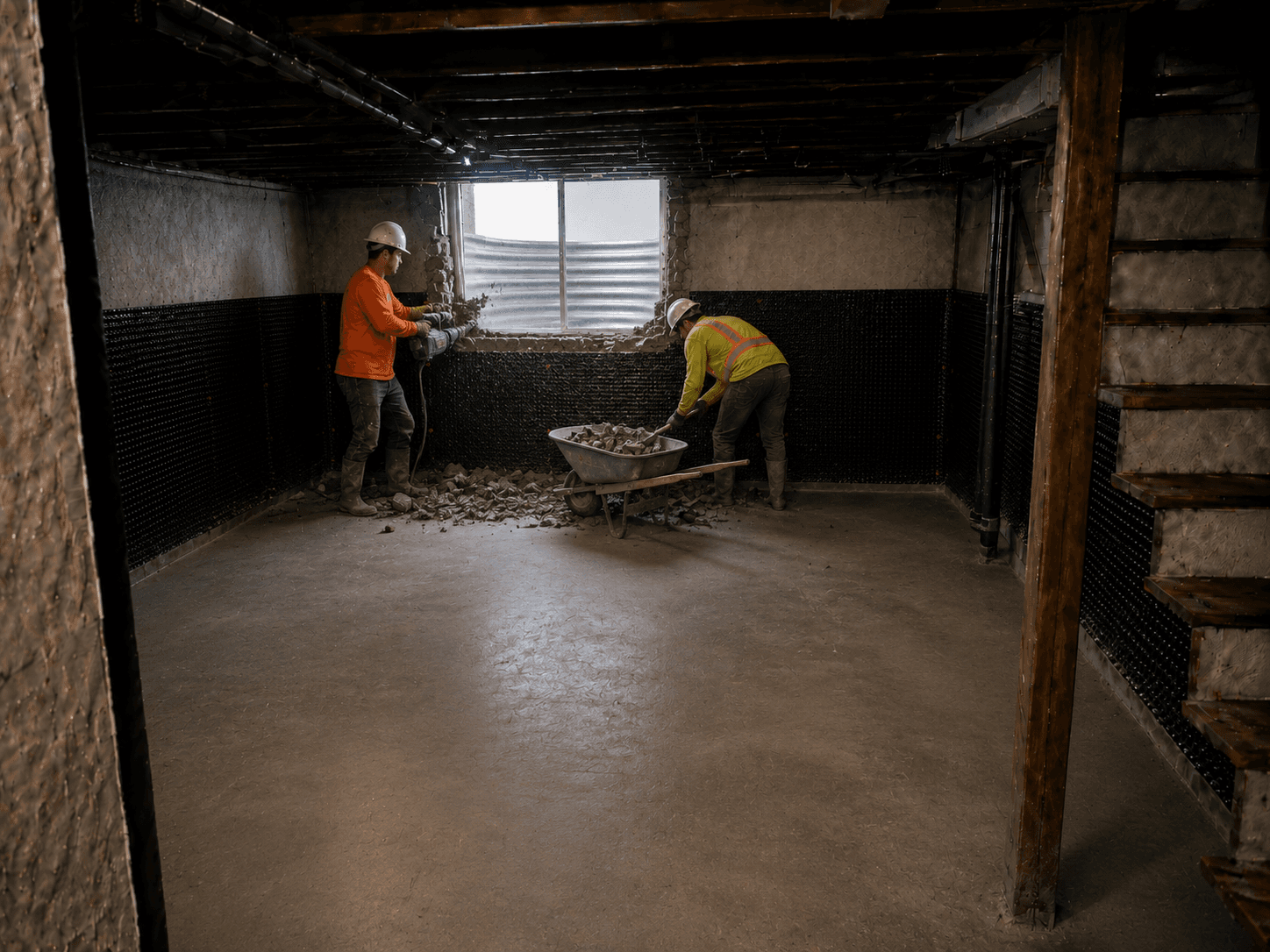

A code-compliant egress window is cut into the foundation wall, providing natural light and a safe emergency exit. Required by building code for any basement bedroom.

New egress window installed in foundation wall

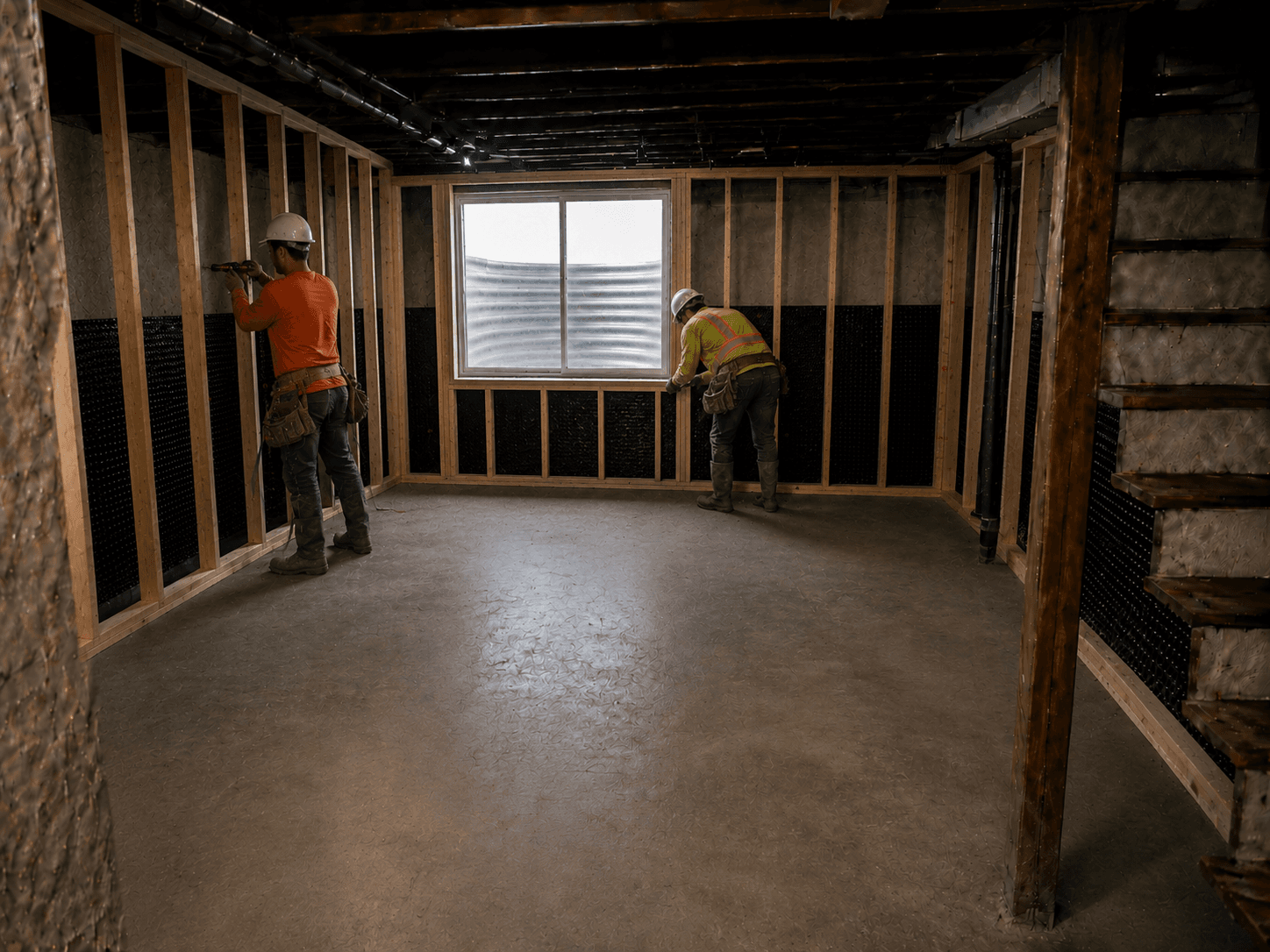

18Framing

Wall Framing

Interior stud walls are framed against the foundation, creating the cavity for insulation and services (electrical, plumbing). Layout follows the approved floor plan.

Wood stud wall framing in basement
19Insulate

Insulation

Batt or spray-foam insulation fills the stud cavities, meeting Ontario Building Code R-values for below-grade walls. Proper insulation eliminates cold walls and condensation.

Insulation installed in basement wall cavities
20Vapor Barrier

6 Mil Poly (Walls)

A continuous 6 mil poly vapor barrier is stapled over the insulated walls, preventing interior moisture from reaching the cold foundation surface.

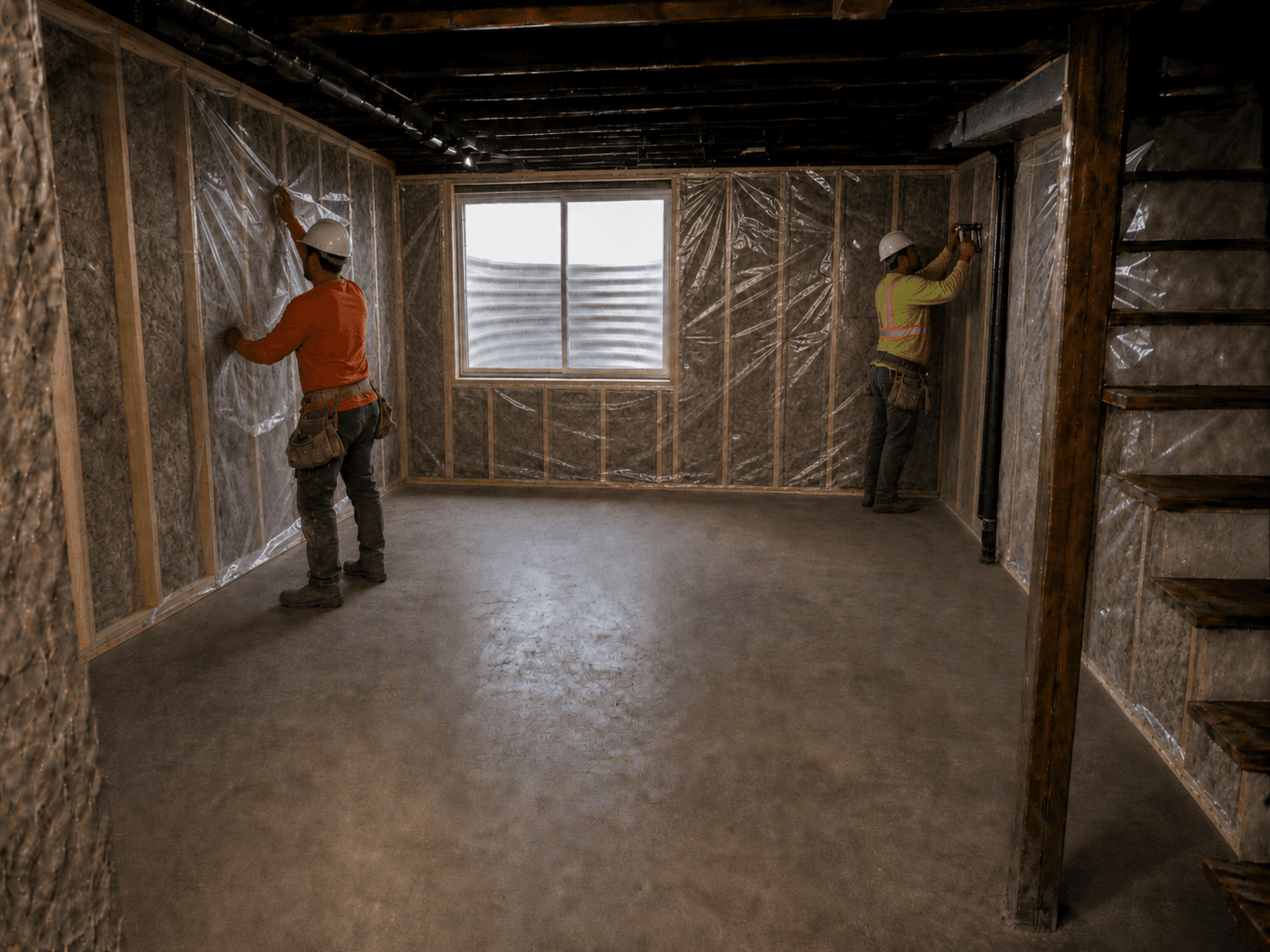

6 mil poly vapor barrier on insulated basement walls
21Drywall

Drywall Installation

Drywall sheets are hung, taped, mudded, and sanded. The basement starts to look like a real room. Corners and joints are finished to a smooth Level 4 finish.

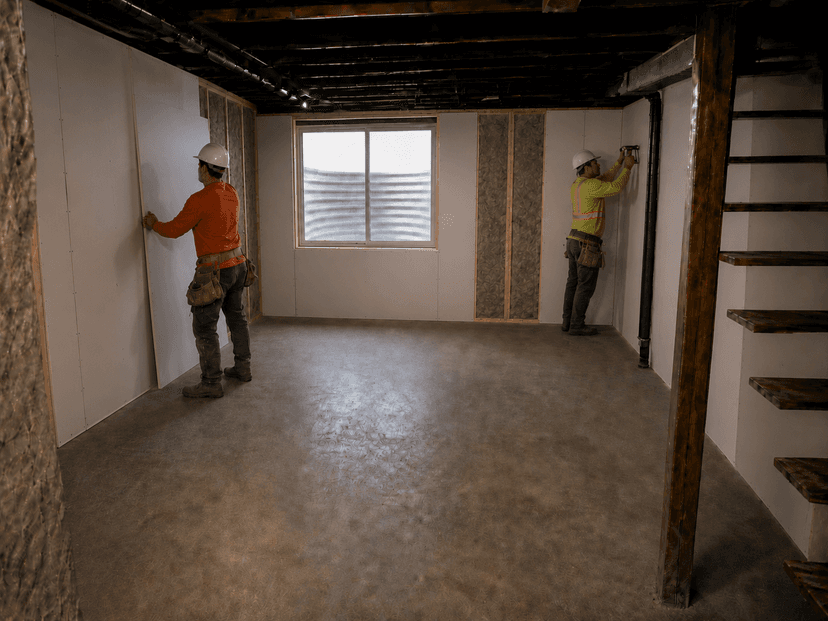

Drywall being installed on basement walls
Drywall taping and mudding in progress
22Stairs

Staircase

The staircase is rebuilt or refinished to match the new floor elevation. With the lower floor, stairs get proper headroom and code-compliant dimensions.

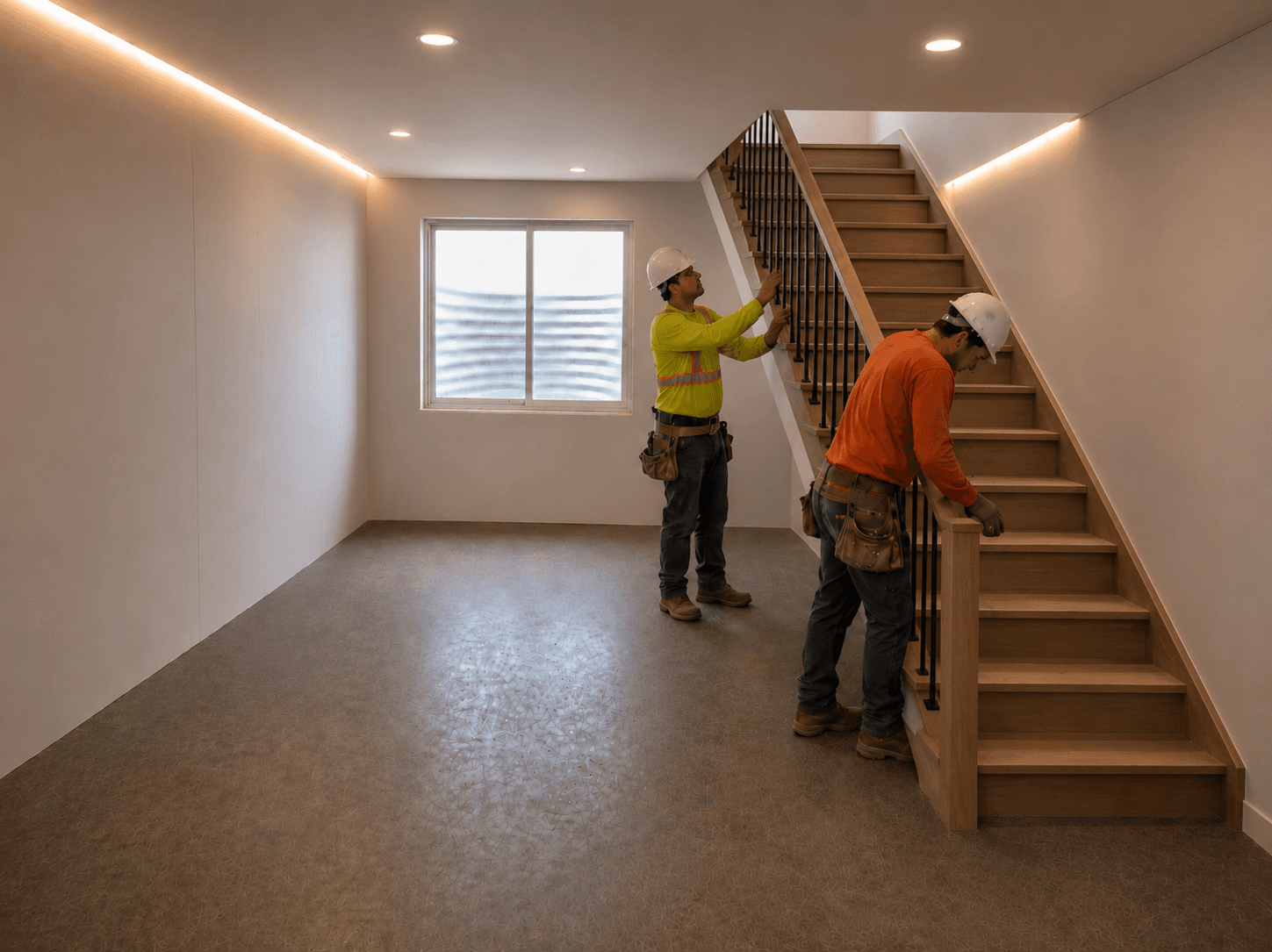

New staircase installed to basement
23Trim

Molding & Trim

Baseboards, door casings, and crown molding are installed — the details that make the space feel finished and polished.

Molding and trim being installed in finished basement
24Paint

Paint

Walls and ceilings get a fresh coat of primer and two coats of finish paint. Light colors are common to maximize the feeling of space in a basement.

Freshly painted basement walls
25Details

Accessories & Fixtures

Light fixtures, outlets, switches, and hardware are installed. The electrical panel is finalized and inspected.

Electrical fixtures and accessories installed
26Done

The Finished Space

From a dark, damp crawl space to a bright, warm living area with full ceiling height, radiant heat, egress windows, and a modern finish. This is the transformation that underpinning makes possible.

Beautiful finished basement after complete underpinning project

Frequently Asked Questions

How long does underpinning take for a typical Toronto house?
About 3 weeks (19 working days). Weeks 1–2 are for section-by-section underpinning (excavate one day, pour the next, alternating sections). Week 3 covers slab removal, drainage, waterproofing, and the new floor slab. Finishing (framing, drywall, paint) is additional.
Why do you alternate underpinning sections instead of doing them in order?
Adjacent sections are never open at the same time. We alternate (1 → 4 → 2 → 5 → 3 → 6) so each poured section has time to cure and regain structural strength before its neighbour is excavated. This protects the foundation throughout the process.
How deep do you excavate for underpinning?
Typically 4 feet below the existing footing, but the exact depth is determined by the structural engineer based on soil conditions, desired ceiling height, and the home's load requirements.
Do I need a permit for underpinning in Toronto?
Yes. Underpinning requires a building permit from the City of Toronto (or your local municipality). You'll also need a structural engineer's report. Your contractor should handle the permit application as part of the project.
What is the dimpled membrane for?
The dimpled membrane creates an air gap between the foundation wall and the finished space. Any moisture that seeps through the concrete is channelled down the dimples into the perimeter drain — keeping your finished basement dry.
How much does underpinning cost in Toronto?
Mass-concrete underpinning costs $500–$800 per linear foot, and a full basement lowering for a typical Toronto semi or detached house runs $75,000–$150,000 all-in — including roughly $5,000–$12,000 of combined engineering and permit costs. The final number depends on the number of sections, depth, soil conditions, and access. Get a free estimate at renonext.com/price-check.
Can I live in the house during underpinning?
Yes, in most cases you can stay in the house. The work is contained to the basement. There will be noise and dust during working hours (typically 7 AM – 5 PM, Monday to Saturday), but the main floor remains livable.
What are the 1200 mm sections?
The foundation wall is divided into 1200 mm (about 4 feet) wide sections. Each section is excavated, formed, and poured independently. This width is standard — wide enough to work in, narrow enough to maintain structural stability on both sides.

Ready to Transform Your Basement?

One licensed crew handles your underpinning from permit to pour — with a live client app so you can follow every section. Free estimates, transparent pricing.

Planning a project in the city? See our complete underpinning Toronto guide — costs, permits, and neighbourhood-by-neighbourhood advice.
